אוסמוז

Launch dossier · Confidential · August 2026

Pressure washing
reaches the top floor

A lift drone carries the lance to the top of the building. No scaffolding, no boom lift, no closed pavement.

§The co-founders

Two brothers, two complementary halves of the same trade: one reads the building and builds the tools, the other knows pressure and the field.

DavidDavidCo-founderTwelve years of pressure washing in France — drain unblocking, drain jetting, network maintenance. He knows pressures, nozzles and what a surface can take without being damaged. Recently moved to Israel, investor profile: he knows what a production day is worth and he arbitrates the spending.
JonathanJonathanCo-founderEngineer, ten years in Israel, and the idea comes from him. Former RGE-certified auditor in France: he reads a building and masters the trade software. Passionate about technology, he carries the website, the CRM and the marketing — so the roll-out and the virality.

§Operational summary

We are setting up a cleaning company in Israel specialised in pressure washing, with the drone alongside. The drone is not the trade: it is the means of access that carries pressure washing up to the top floor, without scaffolding and without a boom lift.

·The five facts that sum up the dossier

  1. The market exists and nobody serves it. Close to three million homes in Israel, most of them in blocks of flats, and five drone operators who address only Intel, the Israel Electric Corporation and Dead Sea Works.
  2. The drone does not occupy the street. No scaffolding, no boom lift, no highway permit, no closed pavement. In an Israeli city centre, that is the argument that gets the contract signed.
  3. Regulation is a barrier, not an obstacle. The 2024 regulation effectively prohibits our trade without a special operating authorisation granted on file. It takes months and it has to be earned. Once obtained, it cannot be bought.
  4. We are not starting from nothing, and pressure washing is not a side trade. Drain jetting and pipe maintenance have been David’s trade for twelve years, and it is exactly the same physics applied vertically. A single van carries the drone and the ground equipment. In concrete terms: pressure washing invoices from the third month and keeps the company alive while the flight file is being processed, it fills the days when the wind grounds the aircraft, and it opens the doors of the same clients. It is half the model, not a spare wheel.
  5. The founders take no salary in the first year. They are paid at the end of the financial year, out of the result.
The bet, stated plainly. No Israeli drone operator has yet succeeded in the residential segment. We believe this is a problem of sales organisation, not of market: selling a 5 600 to 22 500 ₪ job to a building committee that votes at a residents’ meeting takes a sales machine that engineering companies have never built. That is precisely what we know how to do. This dossier does not hide that bet, it documents it and puts figures on it.
Why this market and not another. We analysed it before committing: no serious competitor, and almost no online presence — the five drone operators active in the country all target industry and large accounts, and none has a verifiable residential reference. Whereas the project is, by nature, viral: it is watched, it is filmed and it is shared. That is exactly the ground on which our skills are worth something.
What we are asking the bank for, and what we are not. We are not asking for money to live on: the 600 000 ₪ of founders’ equity contribution covers the start-up and the cash position never goes negative. We are asking for equipment financing of 369 000 ₪ — 199 000 on the van and 170 000 on the two aircraft, as a balloon loan pledged in favour of the lender, that is 6 866 ₪ a month over forty-eight months. And a 100 000 ₪ overdraft facility as a safety net, which costs nothing as long as it is not drawn. The rest — production equipment, pressure washing equipment, van racking and fit-out, start-up costs — comes out of our own pocket, that is 360 000 ₪ of equipment contributed by the founders.

600 k₪
Founders’ equity contribution, available
369 k₪
Equipment financing requested · van and drones
100 k₪
Safety overdraft facility
783 k₪
First-year revenue

1The marketExplanations

1.1How a façade is cleaned in Israel today

Three methods, all of them older than on-board electronics. The rope access technician abseils down from the roof: quick to set up, but the cost follows the height and the risk follows the man. The boom lift raises an operator from the ground: cheaper up to six storeys, but it takes a traffic lane, a highway permit and parking spaces. Scaffolding is only justified on long jobs.

Nothing has moved in twenty years. A mature, fragmented market — close to two thousand companies listed — running on manual quotes and word of mouth.

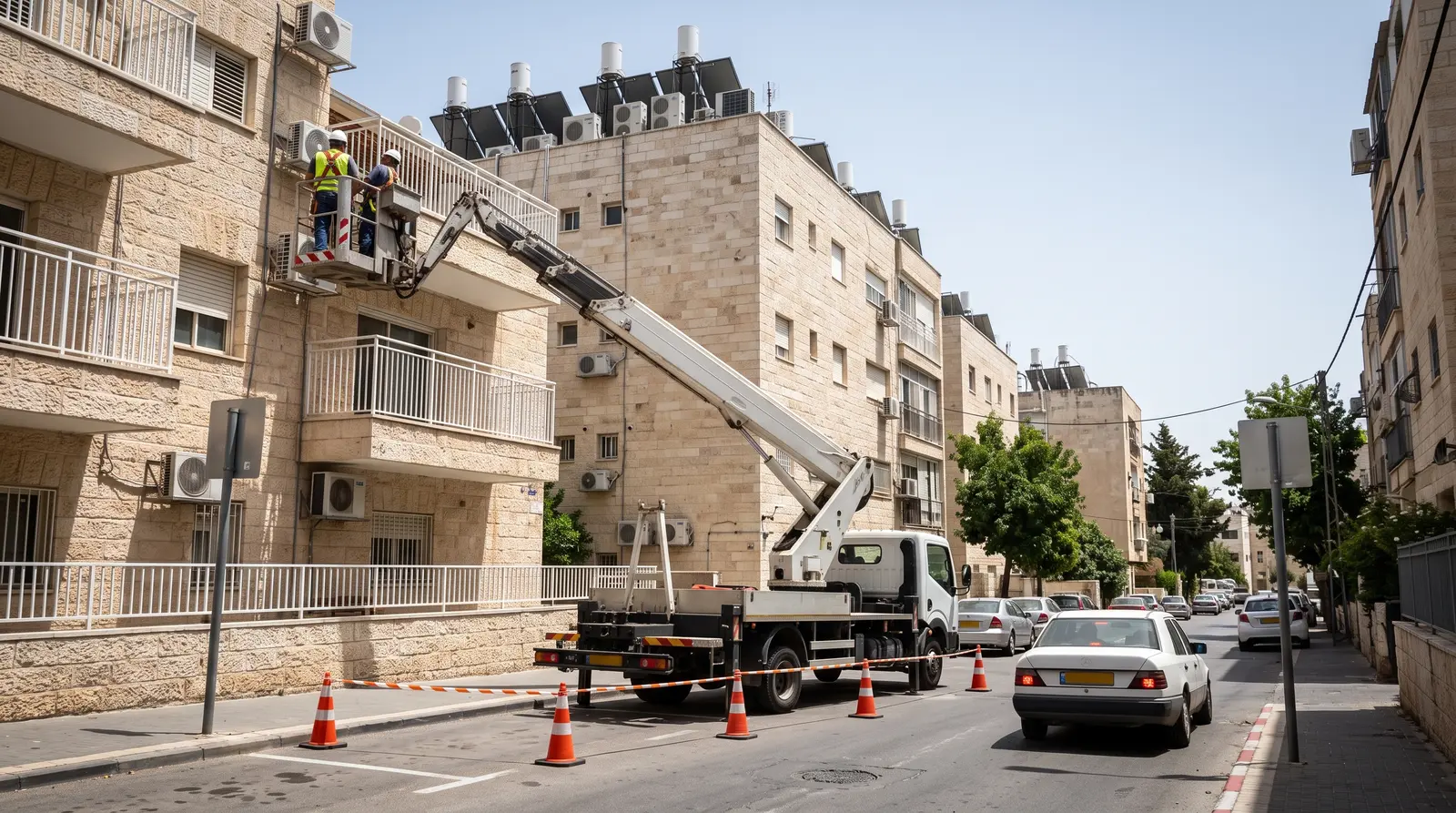

Boom lift occupying a traffic lane in front of a residential building1.1

1.2The real cost of the current methods

Method Observed price Constraints
Rope access 30–50 ₪/m² · flat rate 3 300–5 900 ₪ per building · team 3 000–3 500 ₪/day Surcharge of 15 to 25% above 11 storeys, 25 to 40% above 20; +20% in the coastal strip
Boom lift 2 500–15 000 ₪/day depending on height 20 to 30% cheaper than rope access up to 6 storeys, but highway permit and occupation of the carriageway
Scaffolding Quoted per project Long immobilisation, heavy nuisance for residents
What these figures say, and what we accept. On 4 to 6 storeys — our core target — the boom lift is already the cheapest solution. We do not arrive with a price advantage, but with a nuisance advantage: nothing on the ground, nothing blocked, one day instead of three.

1.3The addressable stock

Israel has around 2.96 million homes, growing by more than 61 000 units a year. New construction is vertical: in 2024, 47.5% of new homes were in buildings of nine storeys or more, and close to 80% of the floor area started was residential.

Verticality is concentrated where we want to work. In 2023, the homes started in towers of sixteen storeys and above were counted first in Bat Yam (1 486), then Ashdod (732), Lod (697), Netanya (694) and Rishon LeZion (651). Tel Aviv comes only eighth with 426 — but that is where parking is impossible, so that is where our argument carries the most weight.

Israeli seafront residential towers marked by saltאוסמוז

Sea salt changes the nature of the need along the coastal strip. A façade exposed to spray degrades visibly in two to three years, where an inland building holds for ten. Bat Yam, Ashdod and Netanya therefore combine both vertical density and a recurring need — that is where we open.

The exact number of buildings in co-ownership (בתים משותפים, jointly owned buildings) is not covered by any consolidated official publication. Our working estimate, derived from the share of homes in blocks of flats, is between 100 000 and 180 000 buildings. We build no financial projection on that figure.

1.4Our two markets

We address two client bases with two aircraft, two regulatory regimes and two timetables.

Offer AResidential and small blocks Offer BHigh rise
Share of jobs 75% 25%
Target Buildings of 3 to 10 storeys, small building committees, villas Residential towers, hotels, offices, industrial sites
Aircraft Two drones under 25 kg Industrial system over 25 kg
Regime 2024 regulation, pilot licence, special operating authorisation 1981 regime, air operator status, certificate of airworthiness
Available from Month 7 Month 24
Typical duration 1 to 2 days Three to five days
Average ticket 9 812 ₪ 20 000 ₪

This sequence is not a matter of comfort, it is the structure of the dossier. Offer A starts early, under the lighter regime, with two light aircraft; it then finances the opening of offer B, which demands a far longer regulatory path. We are not asking the bank to finance two simultaneous bets, but a first one that pays for the second — and the purchase of the heavy drone is only committed in month twenty if the first eighteen months have delivered what they promised.

1.5Seasonality and recurrence

Two seasons drive the activity. From November to March, rain and wind cut the number of flyable days — we allow for a loss of about 25% of drone activity over those five months, a figure carried straight into the forecast. From April to October, dust and khamsin episodes soil façades quickly, and demand peaks before the Tishrei holidays, when building committees traditionally vote their maintenance work.

That is exactly why ground-level pressure washing is not a side activity but a shock absorber. On the days the drone stays on the ground, the team handles car parks, lobbies, terraces and drains, with the same van and the same clients. None of our drone competitors can do that.

1.6The competition

Five drone operators identified in Israel. All of them announce residential work on their website. Not one shows a single reference for it.

Operator Documented references Actual segment
E-DRONE Intel Haifa, Dead Sea Works, Atidim complex · 1.2 million m² claimed Industry and large accounts
Aquadrone No case study published Announces residential towers, without proof
KTV Working Drone No named reference Infrastructure, energy, oil & gas
TDrone No named reference Buildings, solar, wind, aeronautics
DXG Drone Services Website unreachable Not determined

A foreign franchise, Drone Sky Cleaners, markets an Israeli territory, without any active franchisee having been identified.

How we read it. Five companies, equipped and authorised, all of them advertising residential work and none of them doing any. Either the segment is worth nothing, or it demands a trade they do not have: prospecting, fast quotes, follow-up with the building committee, chasing. We think it is the second. Our real competitor is not E-DRONE, it is the rope access technician round the corner.

2The solutionExplanations

2.1The principle

A carrier drone, fed from the ground through a hose, sprays pressurised osmosis water onto the façade. The water, stripped of its minerals by a reverse-osmosis unit carried in the van, dries without leaving a mark: no squeegee, no detergent residue, no human contact with the surface. The pilot works from the street; the ground operator manages the buffer tank, the water supply, the pump, the safety marking and the visual watch the regulations require.

The façade of a six-storey building is done in half a day, and no resident has to keep the windows shut for more than an hour.

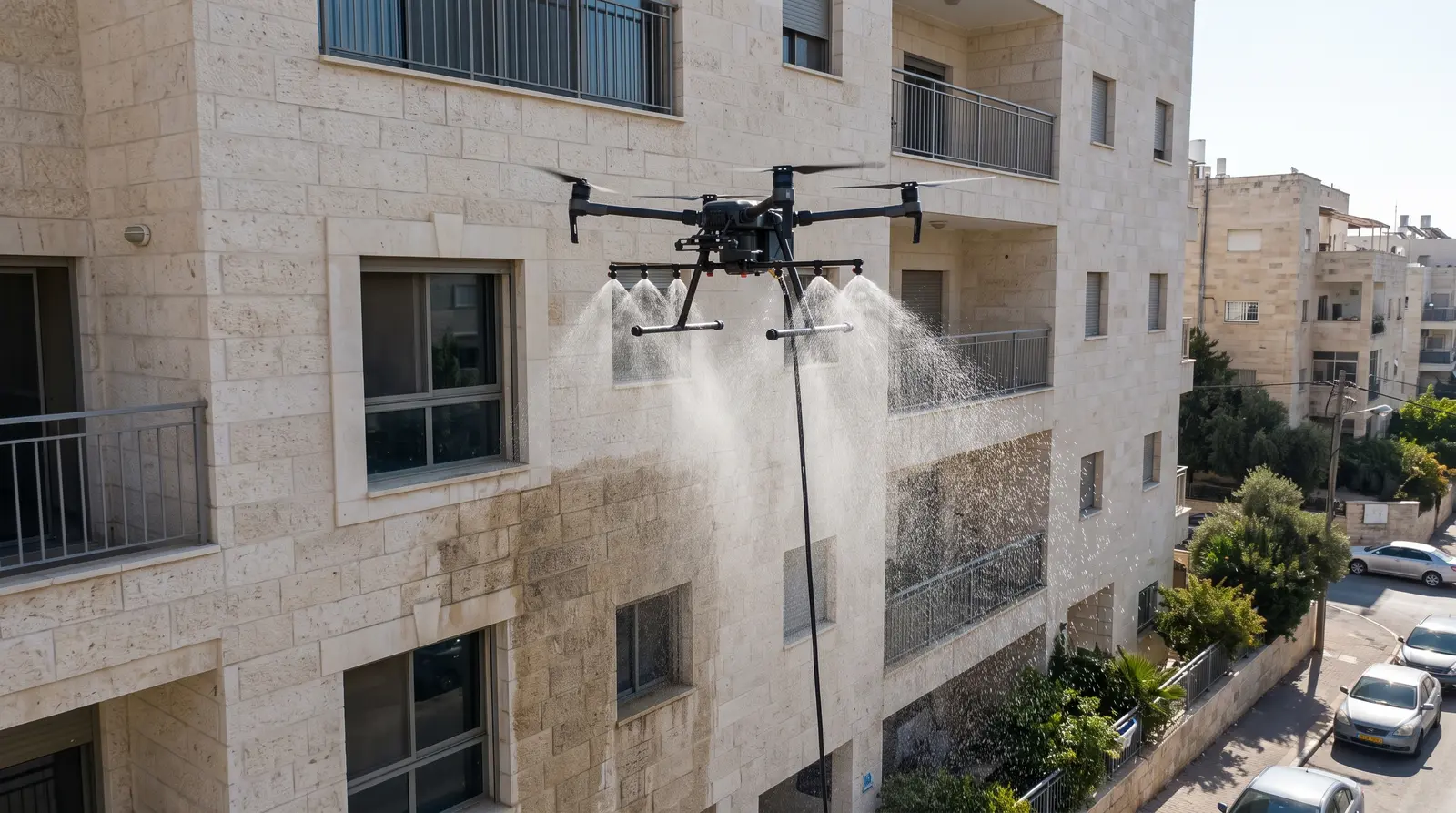

Cleaning drone spraying water onto a glass façade, supply hose running down to the groundאוסמוז

2.2What the drone does, and what it does not

Where the drone excels Where the drone is the wrong tool
Glass, aluminium, cladding, smooth stone, painted concrete Ingrained soiling, graffiti, thick old moss
Continuous, unobstructed surfaces Deep balconies, enclosed loggias, architectural recesses
Solar panels, glass roofs, canopies out of reach Wind above roughly 30 km/h
Buildings where ground access is impossible Work needing mechanical contact (scraping, sanding)

We say so to the client before we sell. A job sold on a promise the drone cannot keep costs us a bad review, and our strategy rests on reviews. When the façade needs contact, we propose a mixed job: the drone for the surfaces, a subcontracted rope access technician for the hard points. We remain the main contractor and the client deals with one company only.

2.3The comparison that wins the signature

Criterion Drone Rope access Boom lift
Time on site (six-storey building) 1.5 days 2 to 3 days 2 days
Road space taken None Limited A full traffic lane
Municipal highway permit No Depends on the site Yes
Parking spaces taken out One space One space Three to five
Staff exposed at height None One to three One to two
Scheduling lead time 10 days 2 to 5 days 10 to 20 days (permit)
Photo and video report of the façade Included No No

Our ten-day scheduling lead time is a regulatory constraint we cannot compress. Against a boom lift, which needs a highway permit on a similar timescale, it does not penalise us. Against a rope access technician it costs us a few days — which we offset with a job four times shorter and free of nuisance.

2.4The aircraft

We start with two aircraft under 25 kg, from two different manufacturers. This is not comfort redundancy: a grounded drone means a crew on the payroll producing nothing and a job pushed back ten days, because a flight authorisation cannot be caught up. And the cleaning-drone market is young enough that six months of side-by-side operation teach more than a year of spec sheets. Whichever model holds up becomes the standard for the second crew.

Two aircraft in month 2, for about 270 000 ₪ delivered to Israel — the order is conditional on a delivered price at or below 135 000 ₪ per aircraft, failing which a second Matrice 400 fitted with the cleaning kit takes the place of the Hercules: the Hercules 10 Tethered Spray and the DJI Matrice 400 fitted with a cleaning kit. A third in month 14 — the model that will have held up — for the second crew, operational in month 16. And an aircraft above 25 kg in month 20, for the high-rise offer, only if the first eighteen months validate the model. The detail is in section 11.1.

The 25 kg threshold is the line not to cross on the first three aircraft. It means take-off mass, accessories included. The aircraft carries no water — the pump and the tank stay on the ground, supply runs through a hose — but it carries the nozzle bar and lifts the weight of the charged hose. That total is what counts: above 25 kg, operations leave the lighter 2024 regime and fall under the 1981 regulations, written for manned aviation. Real loaded weight will be verified and written into the contract with the supplier before any order.
Before and after cleaning compared on the same façadeאוסמוז

2.5The proof

Every job produces a deliverable beyond the clean façade: a before-and-after sequence filmed from the drone, and a time-stamped mission report handed to the property management company. That report earns its keep three times — it justifies the invoice to the residents, it documents the state of the façade for the building’s insurer, and it becomes our marketing raw material.

A cleaned building is a thirty-second video. Thirty seconds that get published, get shared and sell the next job in the same street.

3The business modelExplanations

3.1The unit that counts: the operating day

The first forecast reasoned in numbers of jobs. That is misleading: a small building and a tower share neither price, nor duration, nor margin. The only unit that really constrains the business is a field crew day, because we have only one crew.

Twenty working days a month, Sunday to Thursday. Wind, rain and flight restrictions take three away: seventeen production days remain. A façade job consumes 1.84 of them on average, at nine hundred square metres washed per day. One crew therefore handles 9.2 jobs a month, and those 9.2 jobs consume the seventeen days in full: at saturation, no day is left for ground-level pressure washing. It does, however, fill everything the schedule lacks — at seven jobs, four days go back to ground work. A second crew doubles that figure, from month 16 and on measured triggers.

3.2The price

We position ourselves inside the rope access price range, never below it. Undercutting a segment held by operators with very low cost structures would be lost from the start. We sell a clean site, speed, and the photo report handed to the property management company — not a discount.

Service Price incl. VAT Duration
Four-storey building 5 600 ₪ 1 day
Six- to eight-storey building 7 700 to 9 700 ₪ 1.5 to 2 days
Tower of 12 to 20 storeys 17 100 to 31 400 ₪ 3 to 5.5 days
Solar panels in a residential building 700 to 1 300 ₪ 2 to 4 hours
Ground-level pressure washing 4 000 ₪ per day per day

The full price list, its surcharges and the quoting rules are in section 12.1.

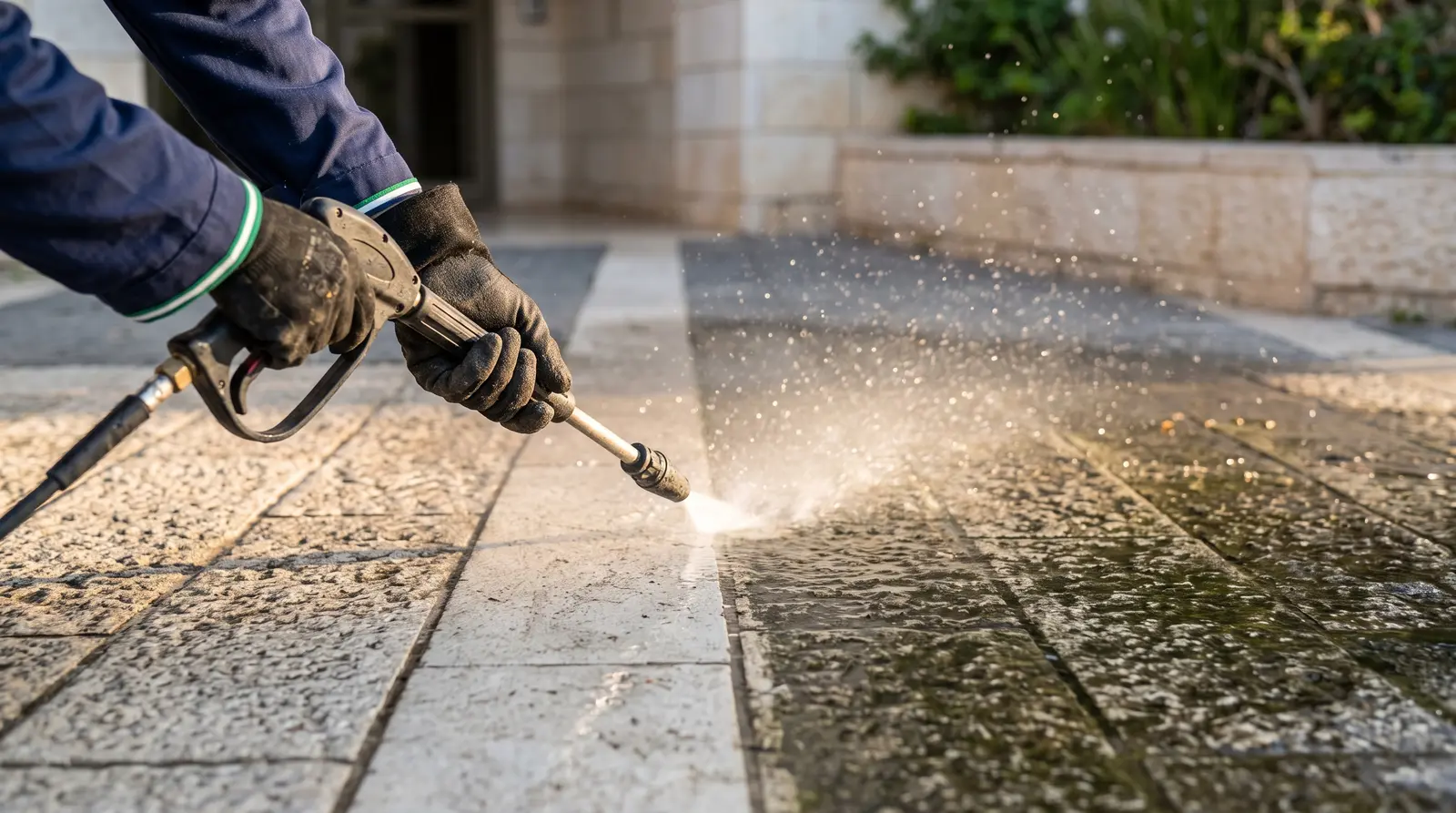

High-pressure lance cleaning the paved entrance of a residential buildingאוסמוז

3.3The typical month, in two stages

Monthly revenue is built in two stages, separated by the arrival of the second crew in month 16 and then by the opening of offer B in month 24.

Item One crew · month 14 Two crews · month 20 Steady state · month 30
Offer A — residential 9.2 × 9 812 ₪ 18.4 × 9 812 ₪ 16.4 × 9 812 ₪
Offer B — high-rise 2 × 20 000 ₪
Ground-level pressure washing 0 d 0 d 3.4 d × 4 000 ₪
Monthly total 90 654 ₪ 181 309 ₪ 214 512 ₪
Crew days used 17 / 17 34 / 34 34 / 34
Look at the first column: a single crew is already profitable. It tops out at 90 654 ₪ a month against a break-even of 79 212 ₪ — 10 069 ₪ of margin, thin but positive, equipment instalments included. That is the result of a deliberately light structure, set out in section 8: an office we already have, marketing done in-house, equipment financed rather than bought, a pilot recruited already licensed. The second crew is therefore not a survival condition but a growth decision, taken on measured triggers.

3.4Recurring revenue, and where it is not

We set no recurring revenue target, and that is a deliberate choice. An annual maintenance contract in a residential building assumes a vote at the residents’ meeting for a spend that already represents 50 to 62% of the building’s running budget in a single pass. At two passes a year, it cannot be voted through. Building a share of recurring revenue on this product would mean promising a lender a line that our own market analysis contradicts.

Recurring revenue does exist, but elsewhere, and the forecast takes no account of it — it is potential, not a promise: solar panels in residential buildings, two passes a year at a ticket the residents’ meeting votes without difficulty; offices and facility management, three to four passes a year on an operating budget; and above all the property management company (חברת ניהול), which runs dozens of buildings, decides without a residents’ meeting and reclaims VAT. One signature, a whole portfolio.

Residential brings something else: volume, street visibility and social proof. A building is washed again every two to three years — that is the rhythm buildings can fund, and it is also the one rope access technicians recommend on technical grounds.

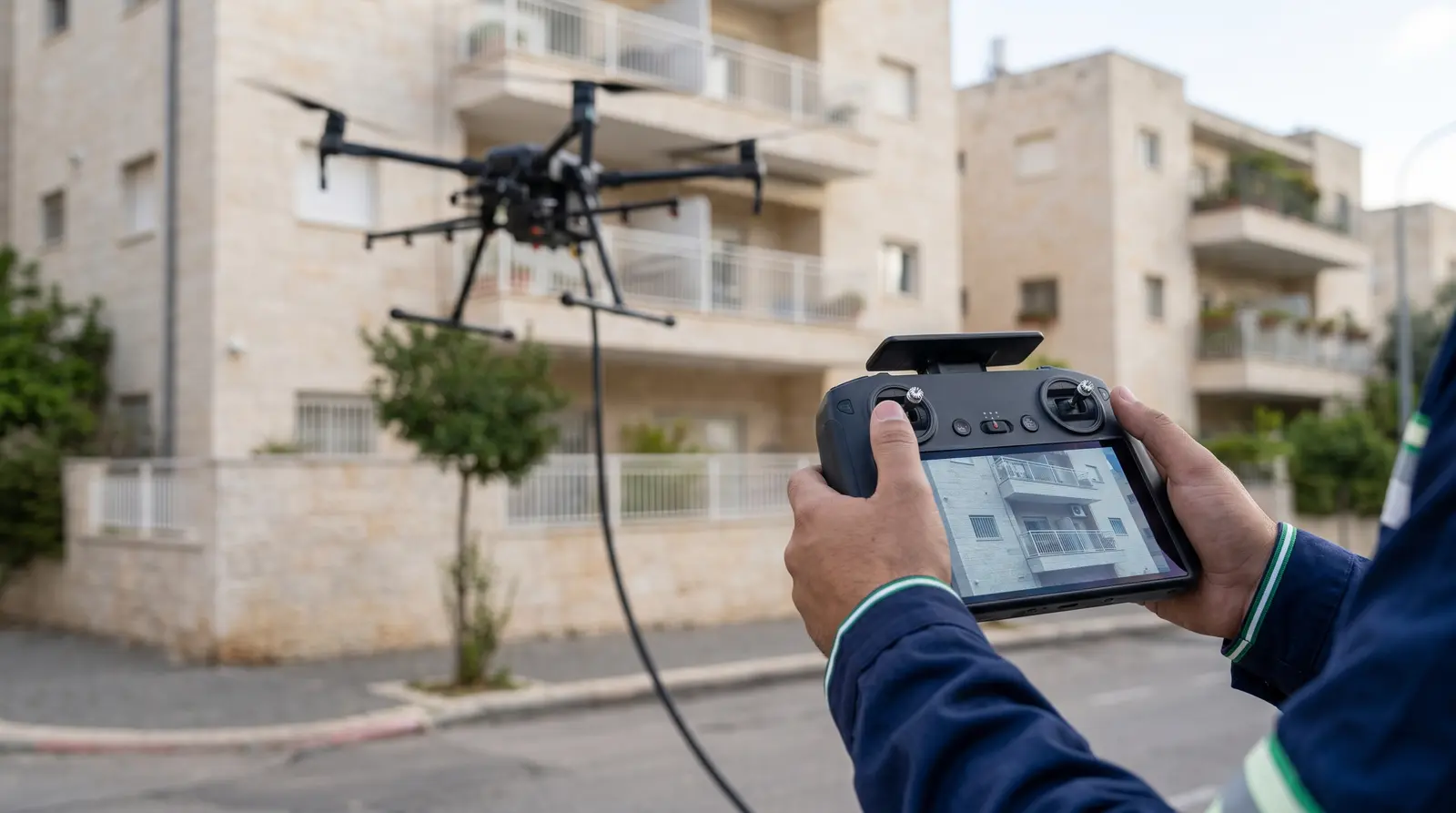

Drone remote controller, façade visible on the screenאוסמוז

3.5Cost structure of a job

Item Six-storey building at 7 700 ₪
Osmosis water, consumables, product 350 ₪
Fuel and travel 270 ₪
Drone wear and maintenance provision 304 ₪
Total variable costs 924 ₪ — 12%
Contribution margin 6 776 ₪ — 88%

The contribution margin is very high, which is the signature of a service business: the whole difficulty is covering the fixed costs, not making money on a job. That is why filling the schedule, and therefore the sales machine described in section 6, comes before everything else.

3.6VAT and tax

The forecast includes Israeli VAT at 18% and corporate income tax. Over the first two months, where we invest without invoicing yet, the input VAT on equipment and vehicles generates a refundable credit that improves the cash position — a point the first forecast ignored and which works in our favour.

4The regulatory barrierExplanations

The most important section of the dossier. It says why the first commercial flight does not take place before month 7 — while ground-level pressure washing invoices from month 3 — and why a competitor cannot catch us up in a quarter.

4.1The applicable text

Drones under 25 kg fall under תקנות הטיס (הפעלת מערכת כטב״ם קטן), התשפ״ד-2024 (the Aviation Regulations on the operation of a small unmanned aircraft system), in force since 11 August 2024. Above 25 kg the 1981 regulations apply, written for manned aviation and considerably more demanding.

4.2The rule that bans our trade

תקנה 32(א)(2) — regulation 32(a)(2). The distance between the drone and any person not involved in the operation must be at least equal to the flight height, or 50 metres, whichever is greater. Maximum flight height is set at 100 metres (תקנה 35(א)(2)).

It is therefore impossible to clean an occupied façade under the standard regime. You cannot be fifty metres from a person and three metres from their window. Flying low does not help: the fifty-metre floor holds whatever the altitude.

Flight authorisation file open on a desk with an annotated mapאוסמוז

4.3The special operating authorisation

The regulations provide the way out themselves. Articles 37 to 43 create the הרשאה להפעלה מיוחדת (special operating authorisation): the director of civil aviation may allow an operator to depart from a closed list of articles, including article 32 on distances and article 35 on heights.

That is our real barrier to entry. It cannot be bought, cannot be subcontracted and does not come with a drone ordered from a catalogue. It is granted on the quality of a safety file and withdrawn at the first breach. It is the only ground where a small, well-organised company builds a lasting lead over better-capitalised players — and document management has been our trade for ten years.

That is why the first spending item of the project is not a drone but a file, and why we write the first ones ourselves: you do not write a procedure you have never carried out.

4.4What is not required

  • No municipal authorisation is required in order to fly. Civil aviation is an exclusively national competence. Neither Tel Aviv, nor Haifa, nor Ramat Gan issues a flight authorisation, and no Israeli municipal by-law deals with drones.
  • The only municipal formalities concern the work at ground level — road occupation, parking — and the drone escapes them most of the time, unlike the boom lift. That is a direct competitive advantage, not merely lighter paperwork.

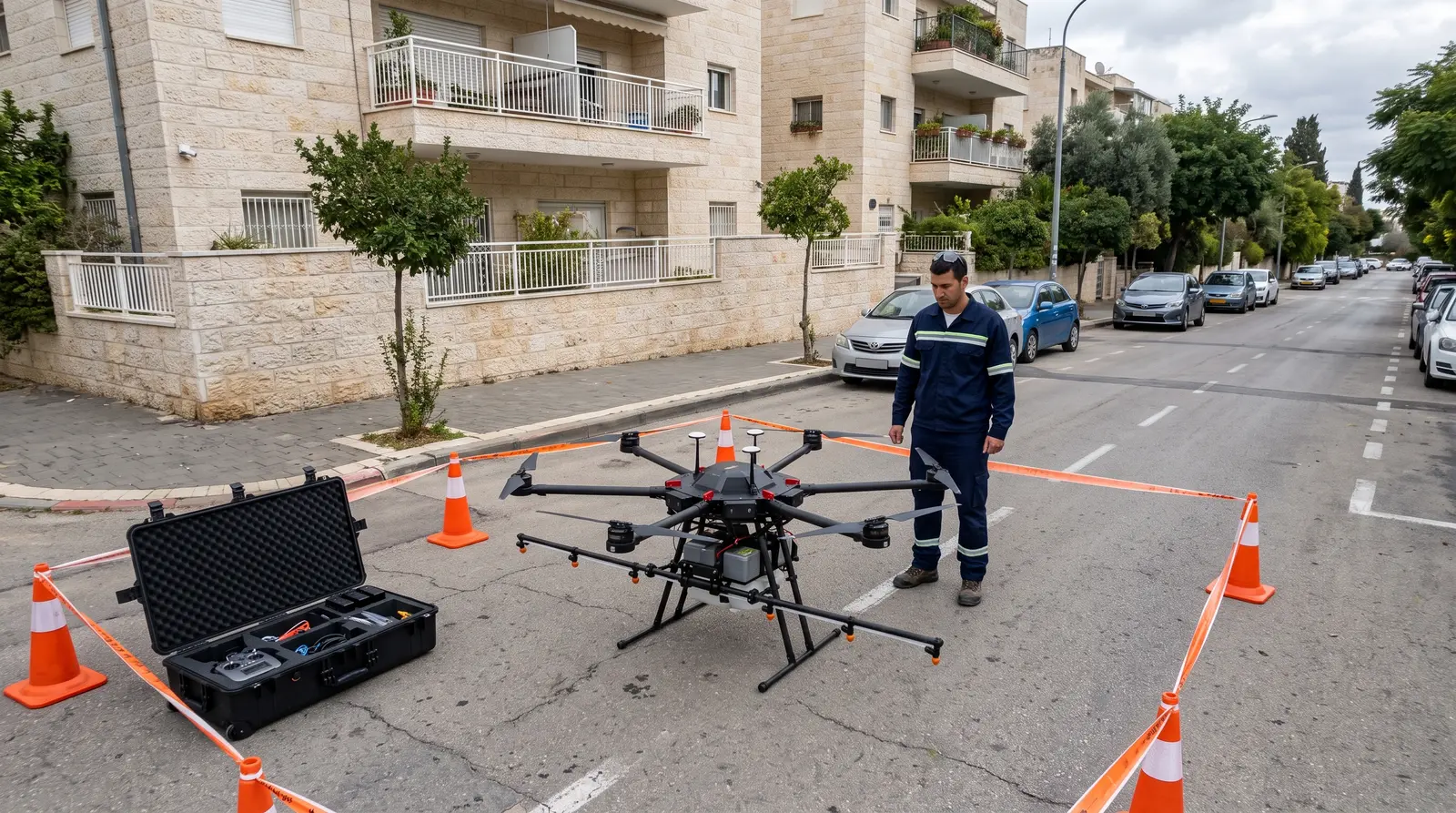

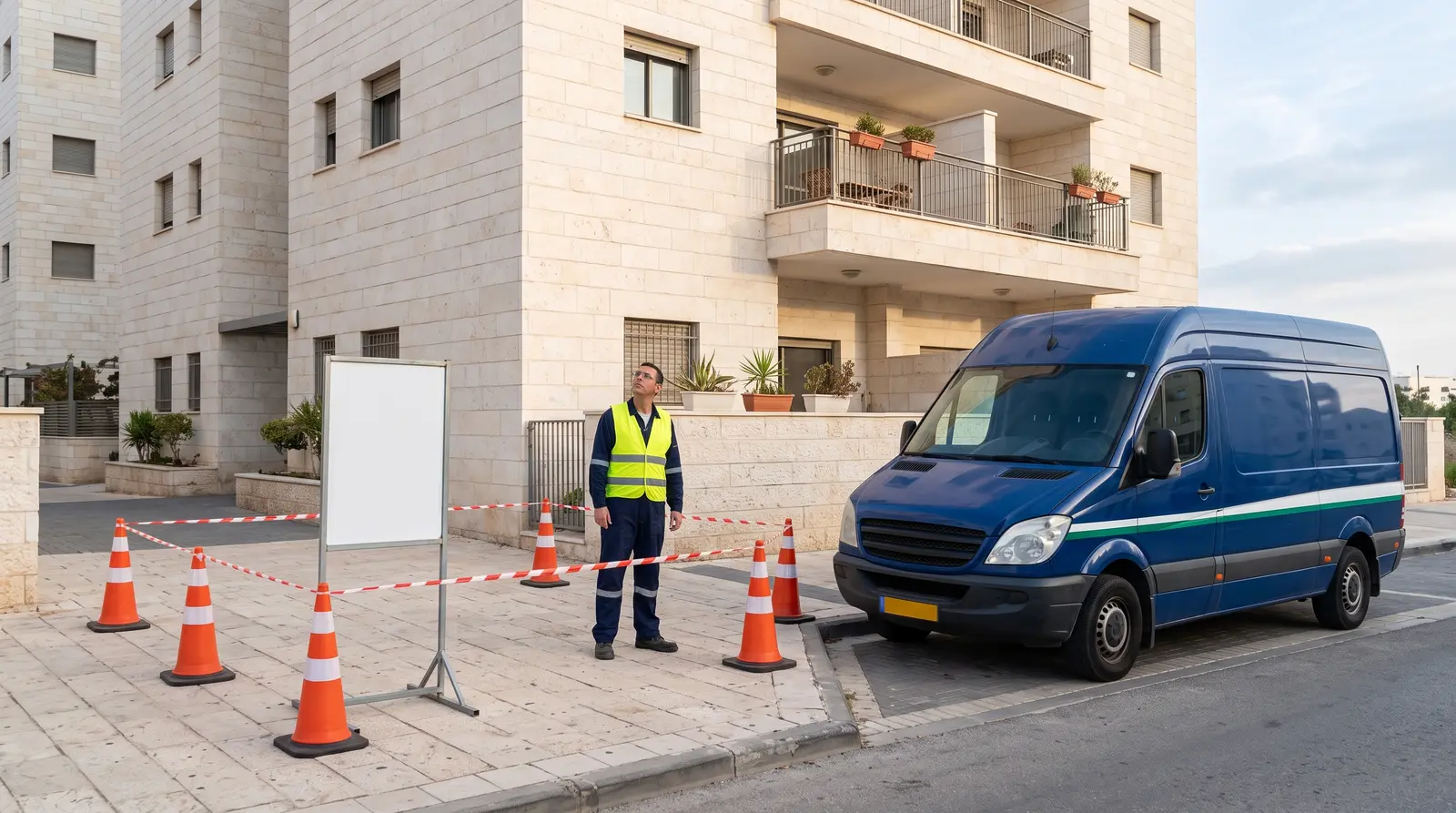

Marked-out safety perimeter on the ground before take-offאוסמוז

4.5The cycle of a job

Timing Action Who
T−15 Site survey: access, ground perimeter, height, no-fly zones, photographic record, technical sheet Sales engineer
T−10 Flight coordination request filed with מודיעין טיס (the flight information unit) — seven working days minimum, forwarded to the air force Administration
T−7 Residents informed, written agreement from the property management company, instruction to close windows Administration
T−1 Check on temporary restrictions and weather, confirmation or postponement notified to the client Crew leader
T0 Safety marking, call to the control unit before take-off, daylight flight, visual observer at all times Field crew
T+1 Mission report, operations and maintenance logs, invoicing, review request to the client Administration

The ten-day lead time cannot be compressed and we sell it as such. Our promise is not immediate intervention: it is a quote within twenty-four hours, a firm date given straight away, and a job that disturbs nobody.

4.6Timeline and plan B

Month Regulatory milestone
1 Company, lawyer, tax registrations. Van and both aircraft ordered. Recruitment of the field pair started. Website and CRM built in-house
2 Van delivered and fitted out, aircraft registered, spectrum authorisation filed. Field pair in post mid-month, settling-in and testing period
3 Risk management plan written with the consultant and authorisation application filed. Ground-level pressure washing in production. Campaign launched at T+90
4–6 Application processed by the authority. First qualified residential leads, quotes issued, insurance taken out
on authorisation Trial jobs, then the first billable drone job, on an order book already built
14–16 Drone A3 and recruitment of the second field crew
18 Review point: does the trajectory justify opening offer B?
20–24 Heavy drone, air operator status, certificate of airworthiness, opening of the high-rise offer

If the authorisation is slow to come, three activities stay open without a waiver and cover part of the fixed costs: ground-level pressure washing, which falls under no air regulation; solar panel cleaning on open roofs, where the distance rule can be respected; and isolated industrial sites, where the absence of third parties nearby makes the flight compliant by nature. We are not left without revenue while waiting for an administrative signature.

5OperationsExplanations

5.1The field crew

A job takes two people, and that constraint is regulatory as much as operational: the regulations require a visual observer separate from the remote pilot.

Role Job on site
Drone pilot Flying, managing the flight path and the distance, deciding to postpone in case of wind, keeping the flight log
Crew leader / ground operator Safety marking, tank and pump, reverse-osmosis unit, permanent visual watch, dealings with the property management company and the residents, shooting the before-and-after footage

Two people make one crew, therefore one drone in the air at a time. The second aircraft adds no production capacity: it guarantees continuity in case of a breakdown, and it serves as a comparative test bench between two models. Increasing volume requires a second pair, not a third aircraft — which is what we do in month 16.

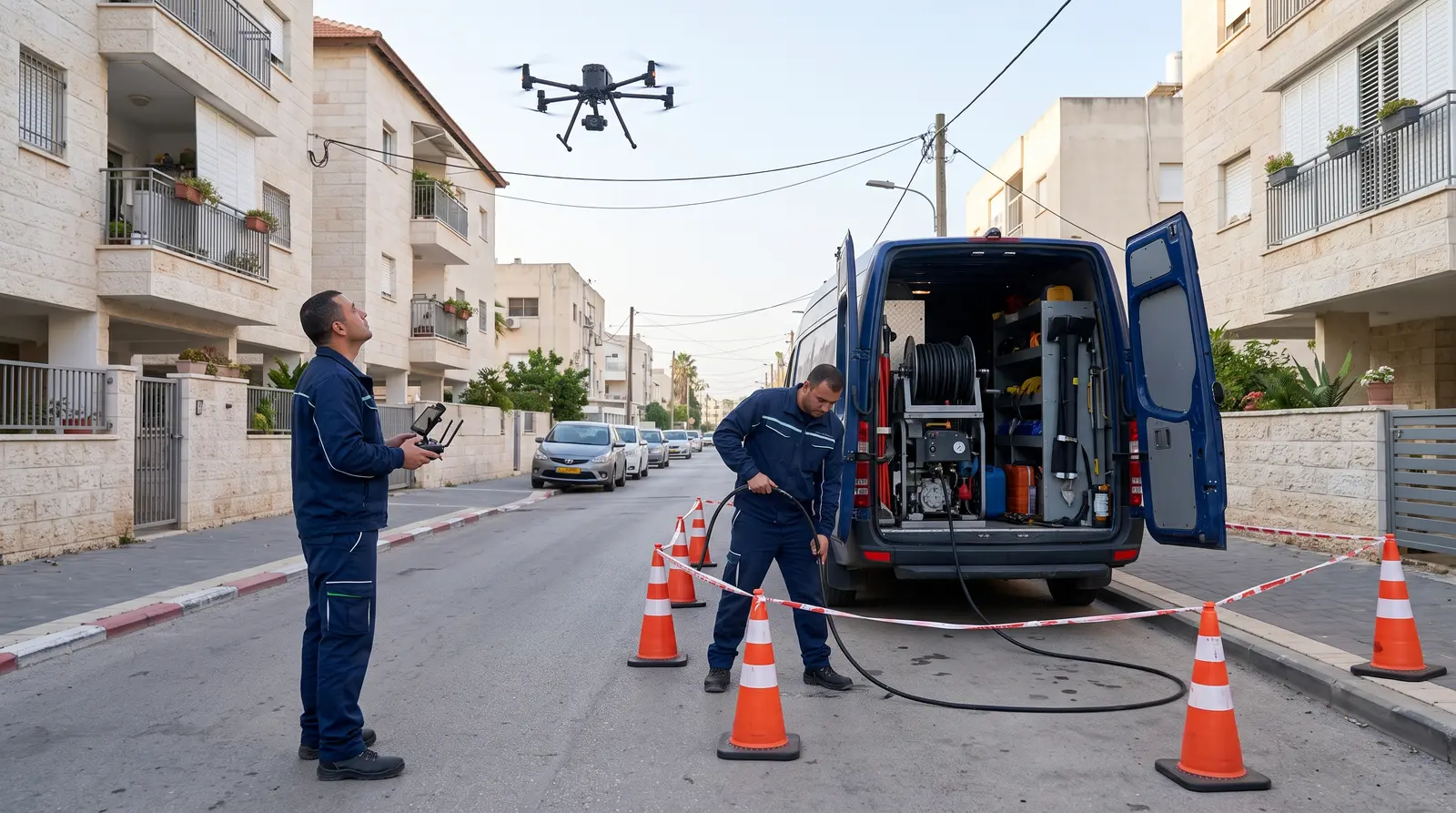

Pilot at the controls and ground operator beside the hose reel, marked-out perimeter, drone in flight behindאוסמוז

5.2Equipment and vehicles

A Ford Transit 399L panel van of 3 990 kg gross vehicle weight, permanently fitted out: a 400-litre buffer tank, reverse-osmosis unit, generator, high-pressure pump, hose reels, and the drone case stowed under cover. The whole fit-out weighs 930 kg against 1 714 kg of payload. A second, second-hand vehicle for the sales engineer’s site surveys. Both are on the road from month 1, well before the first job — a mobile billboard that establishes the brand while the regulatory file is being processed.

One cubic metre of water weighs one tonne. That is what fixes the tank at 400 litres rather than 1 000: beyond that, no vehicle in this class stays within its weight limit when loaded. The tank is a buffer, not a site reservoir — continuous supply comes from the building’s water point through the reverse-osmosis unit. That is standard practice in pure water cleaning, and it is also what feeds the drone in flight.

The detail of prices, of the ten vehicles compared and of the 3 500 kg tax threshold is in section 11.

Vehicle wrapped in the brand colours, site equipmentאוסמוז

5.3Safety and incident management

Our operating authorisation depends on our safety record. Three non-negotiable principles, written into the manual and binding on the crew.

  • The pilot alone decides to postpone. No commercial pressure can make an aircraft take off in excessive wind. The client is told, the date is rescheduled, the contract provides for it.
  • A ground perimeter every time, marked out, with the operator keeping permanent watch. Nobody uninvolved under the working area.
  • Immediate reporting of any incident, even without damage. A concealed incident that surfaces later costs the authorisation; a reported incident costs a report.

5.4Maintenance and availability

A grounded drone is a crew being paid to produce nothing. We provision maintenance inside the variable cost of every job, we keep the maintenance log the authority requires, and we hold a full set of wear parts and batteries. Both aircraft are delivered in month two: from the very first drone job, the second one guarantees continuity on offer A.

5.5Quality as a sales system

Every job ends with a report handed to the property management company, then an online review request forty-eight hours later, sent automatically from our CRM. Reviews are our first acquisition channel in a market where the building committee chooses by recommendation. A successful job is not a job delivered: it is a job that has produced a review and a video.

6Becoming the leader

6.1The positioning

We do not claim to be the first drone operator in Israel — that would be false, and checkable in thirty seconds. We claim to be the first to industrialise residential façade cleaning, while the established operators fight over industrial sites.

The difference is a difference of trade. E-DRONE and its competitors are technical companies that answer tenders. We are building a sales machine: someone on the phone who calls back within the hour, a sales engineer who goes and looks at the building, a quote within twenty-four hours, a firm date, a clean job, a review requested. It is call-out service know-how applied to façades, and it is exactly where we come from.

6.2The filmed job

Our main marketing budget is not advertising, it is production. A drone washing a tower is a spectacle: it stops people in the street, it gets filmed, it gets shared. Every job produces footage usable as a short post, as a sales demonstration and as proof of competence in a tender file.

We are aiming for one post per job from the first month of operation, and a library of visual references built with no additional advertising budget. In a market where nobody shows anything, the one who shows wins.

Passers-by stopped in the street filming the drone at work on their phonesאוסמוז

6.3Acquisition — residential

Channel Target Role
Property management companies Portfolios of 20 to 100 buildings Priority channel: one signature opens a portfolio
Building committees Blocks of 12 to 60 units Direct prospecting by the sales engineer, targeted on visible façade condition
Local search and business listing Inbound enquiries Handled within the hour by the phone sales rep
Social media and video Awareness and inbound demand Fed by the jobs themselves
Customer reviews Recommendation between property managers Systematised after every job

The sales engineer’s prospecting is not blind: a dirty façade can be seen from the street. He spots it, photographs it, identifies the property manager and passes the sheet to the phone sales rep, who calls. The product sells itself by sight.

6.4Acquisition — key accounts

Offer B sells differently: long cycle, tenders, references required. We are targeting hotel chains, office-park managers, hospitals and industrial sites. The first tower job will probably be sold at a loss or at cost: it is a reference we are buying, and it is worth more than its margin.

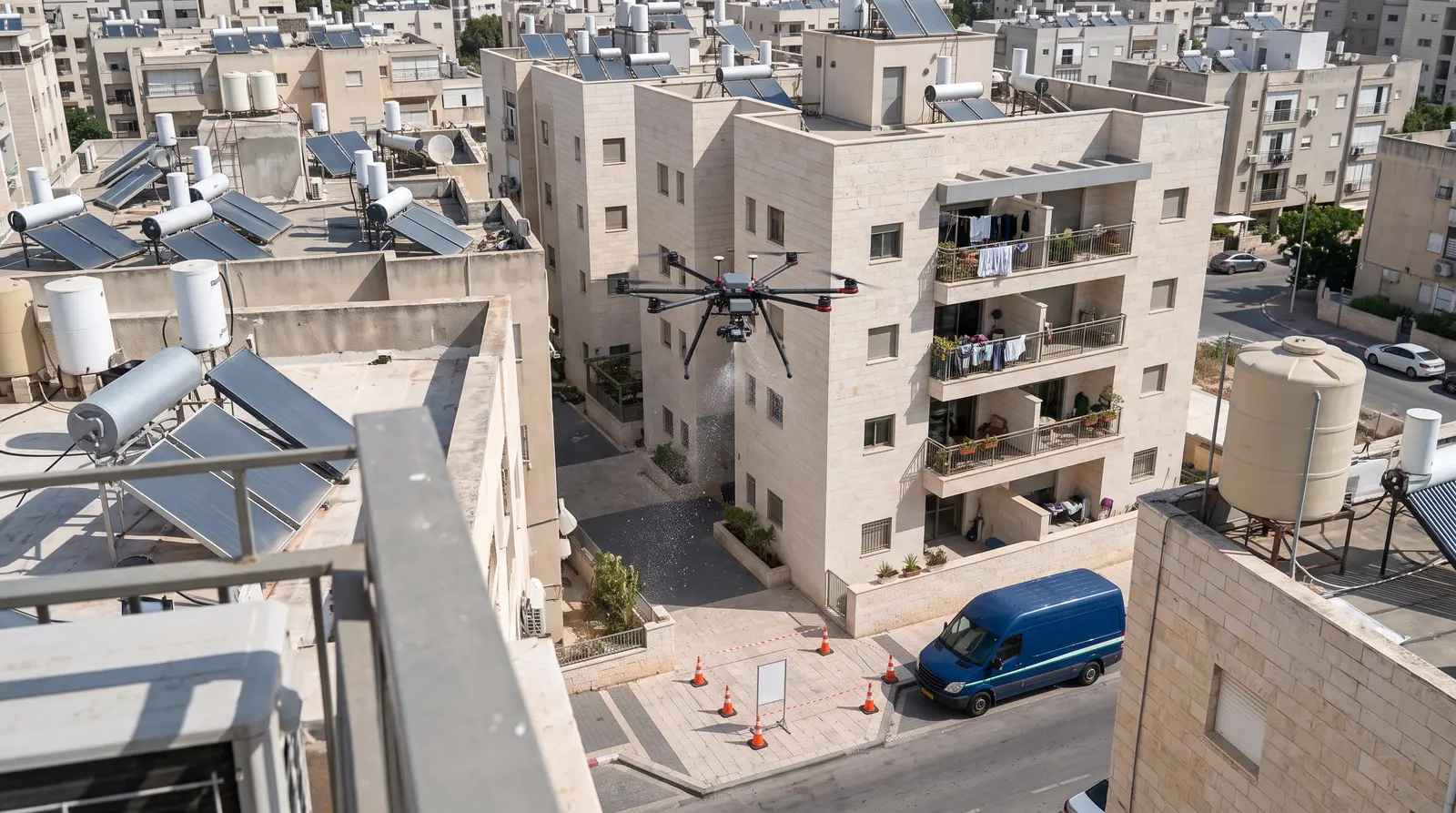

The job seen from above from a neighbouring balconyאוסמוז

6.5The pipeline required

Fifteen jobs a month at cruising speed with two crews — nine with a single one —, with a prudent conversion rate of 25% on quotes issued and 40% of quotes on qualified leads, require about 150 qualified leads per month. That is the only figure that has to hold: everything else in the model follows from it.

150
Qualified leads / month
60
Quotes issued / month
15
Jobs signed / month
7
Site surveys / week

6.6The first ninety days

  • Brand identity, wrapping of the two vehicles, business listing and local online presence.
  • Building the prospecting file: property management companies, building committees, hotels, by priority city.
  • Setting up the CRM and the templates for field surveys, quotes, mission reports and authorisation files.
  • Filming a demonstration video on a private site, with no regulatory constraint, so we can sell before the first job.
  • First meetings with three target property management companies, to sign framework agreements conditional on obtaining the authorisation.

7The team

7.1The founders

Two brothers, two complementary halves of the same trade.

Partner What he brings
JonathanJonathan
the elder, co-founder
Engineer, ten years in Israel. The idea comes from him. Former RGE-accredited auditor in France: he can read a building and knows the sector’s software. Passionate about technology, he carries the website, the CRM and the marketing — rollout, image, virality.
DavidDavid
the younger, co-founder
Twelve years of pressure washing in France — drain unblocking, sewer jetting, network maintenance. He knows pressures, nozzles, water treatment and what a surface takes without being damaged: it is the same physics as a façade, applied horizontally. He knows what a production day is worth and he can price it. Recently moved to Israel, investor and marketing profile: he arbitrates the spending.

We take general management, budgets, decisions and marketing. We build and run our management systems ourselves — website, CRM, job tracking, document automation. That is what makes credible both the regulatory file, which is an exercise in drafting and procedure, and the commercial volume, which is an exercise in organisation. Neither of us draws a salary in the first year; remuneration comes at the end of the financial year, out of the profit.

Neither of us is a drone pilot, and we say so up front. We will take the training required, but once the legal and accounting side is validated — we are not committing to a licence before we know whether the trade can be practised. In the meantime, an already licensed pilot is being recruited for production. In time, three licence holders rather than one: the company never depends on a single departure.
A weakness we own: we run the business in French, not in Hebrew. That is why two of the key posts — the phone sales rep and the administrator — are recruited bilingual, and it is a non-negotiable criterion.

7.2The posts

Post Remit Status
Drone pilot Flying, flight safety, flight log, decision to postpone Recruited already licensed — search launched in month 1, starting mid-month 2
Crew leader Ground operator, running the job site, dealings with residents, filming Candidate identified
Field sales engineer Site surveys, technical measurements, putting together the authorisation files, visual prospecting To be recruited, dedicated wrapped vehicle
Phone sales rep Handling inbound enquiries, quotes, follow-ups, booking appointments — bilingual Hebrew-French To be recruited
Administrator Flight coordination, dealings with the authorities, invoicing, CRM follow-up — bilingual To be recruited at a second stage; covered by the founders at the start

7.3Recruiting the pilot

We recruit a pilot who is already licensed. We do not train one. That is a decision, and it changes the timeline. Training someone means five months of salary paid before the first productive day, a funded licence that walks out with its holder if he leaves, and one more uncertainty in a file that already has enough. Recruiting a trained profile removes all three at once.

The pool exists and it is Israeli. The army trains a large number of drone operators every year. These profiles come out of service with real flight hours, a culture of procedure and safety, and the seriousness an authorisation file demands. It also strengthens our application to the authority: an operator who presents an experienced pilot defends its risk management plan better.

Recruitment starts in the first month, for a start mid-month two. The lead time is no longer training, it is an adaptation and testing period on our own equipment — and it is spent producing ground-level pressure washing, not sitting in a classroom.

Washing drone set down on the pavement, technician beside it, marked-out perimeterאוסמוז

7.4The pay scale

The Israeli minimum wage stands at 6 443.85 ₪ gross per month since 1 April 2026 for a full-time post. No position can be paid below it, commissions included.

Post Gross monthly Employer cost Net, resident Net, new immigrant
Drone pilot 13 000 ₪ 15 600 ₪ ~10 200 ₪ ~10 900 ₪
Crew leader 11 000 ₪ 13 200 ₪ ~8 800 ₪ ~9 500 ₪
Sales engineer 12 000 ₪ 14 400 ₪ ~9 500 ₪ ~10 200 ₪
Phone sales rep 6 450 ₪ floor + commission 7 740 ₪ + comm. ~5 600 ₪ ~5 900 ₪
Administrator 10 000 ₪ 12 000 ₪ ~8 100 ₪ ~8 700 ₪
Founders 0 ₪ 0 ₪ Bonus on the annual profit
Payroll at cruising speed ~63 000 ₪

The employee’s status is a recruitment lever. A new immigrant (olé hadash) receives additional tax credit points: at equal gross, he takes home about 700 ₪ more per month. Put another way, for the same net offered to the candidate, we pay about 900 ₪ less in gross. The employer cost itself does not change. The forecast treats this parameter as a variable, not as a constant.

The employer cost coefficient used (1.20: employer national insurance, compulsory pension provision, severance provision) and the net figures shown are orders of magnitude, to be confirmed by the project’s accountant.

7.5The hiring sequence

Recruiting all five posts in the first month would kill the cash position. The order follows value creation — and it has tightened noticeably since the pilot is recruited rather than trained.

  • Month 1 — nobody, but everything starts. The partners incorporate the company, order the van and the aircraft, build the website and the CRM, open the regulatory file. Recruitment of the field pair is launched in that same month.
  • Mid-month 2 — drone pilot and crew leader. The two arrive together. The pilot is recruited already licensed: what follows is not training but a period of adaptation and testing on our own equipment, done while producing.
  • Month 3 — ground-level pressure washing goes into production. The pair is operational and invoicing, four months before the first commercial flight. The website and the campaign go live at day 90.
  • Month 4 — the sales engineer. He arrives when the first qualified building committee leads come in, so he converts rather than cold-canvasses.
  • Month 8 — the phone sales rep. When there are inbound enquiries to handle, not before.
  • Month 18 — the bilingual administrator. She arrives with the second crew, when flight coordinations exceed fifteen a month and the procedure has been run in by the partners themselves. The single-crew scenario does not recruit her: the partners hold the coordination.
  • Month 16 or later — the second field pair. On measured triggers only, never on the calendar.
What early hiring costs, and what it brings in. Bringing the pair in mid-month 2 rather than in month 7 adds 28 800 ₪ of monthly costs for four extra months, about 115 000 ₪. Against that, it produces seventeen days of pressure washing a month from month 3 instead of the fourteen the partners can cover, and it frees them for the regulatory file and for sales. The operation pays for itself provided the pressure washing days sell — that is the bet, and it rests on our original trade, not on the drone.

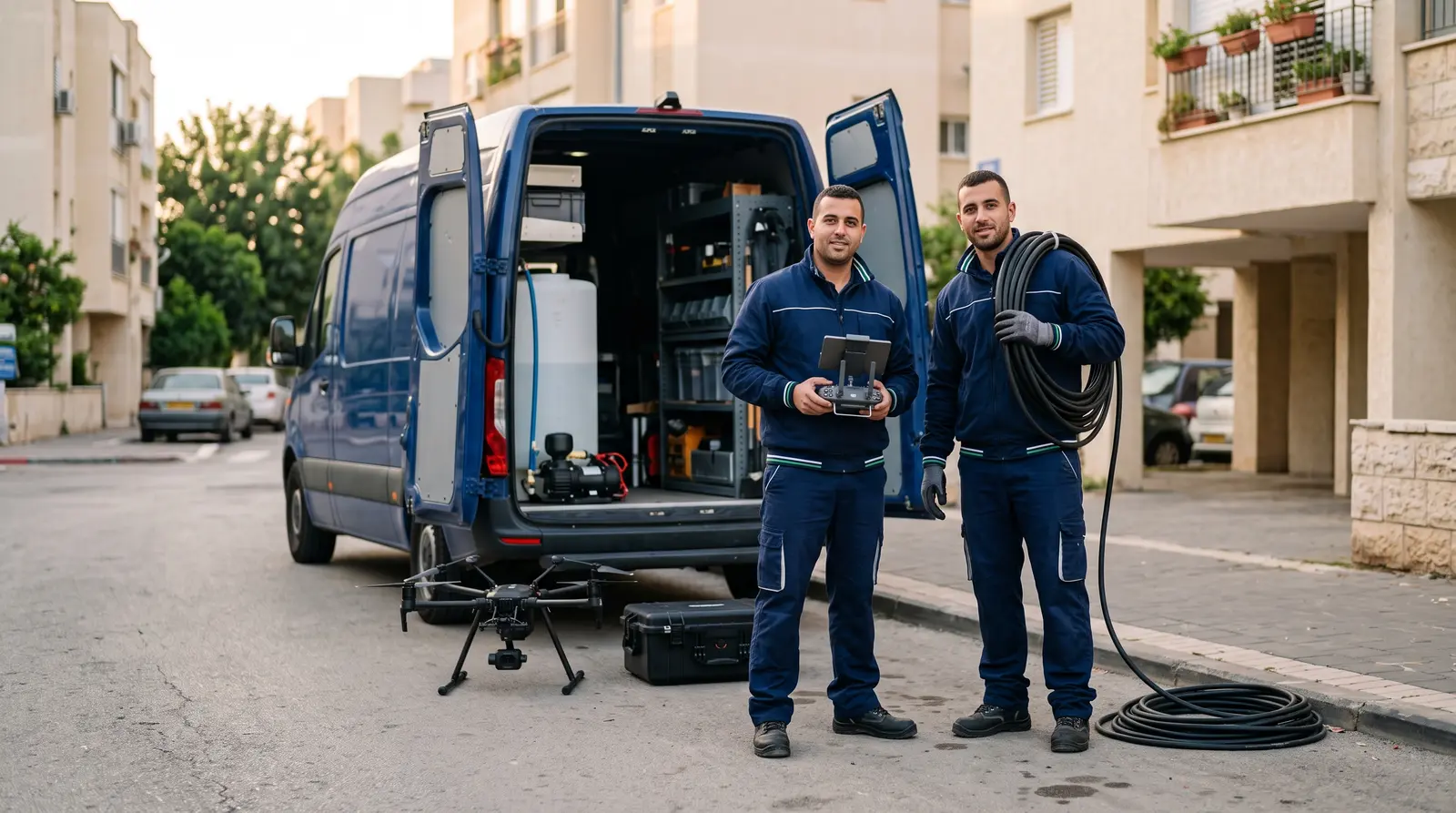

The field pair in front of the van before an interventionאוסמוז

7.6External advisers

  • Israeli lawyer — incorporation, shareholders’ agreement, employment contracts and client contracts, securing the regulatory side.
  • Accredited regulatory consultant — risk management plan and special operating authorisation file. Critical item, engaged first.
  • Accountant — VAT, payroll, employee status, filing obligations.
  • Aviation insurance broker — aviation third-party liability, hull damage, damage to structures.

8The forecastExplanations

The model is built in intervention days, with Israeli VAT at 18%, corporate income tax, seasonality and the collection lag. It is built without any working capital loan: the 600 000 ₪ of founders’ equity contribution covers start-up and operations, and the cash position never turns negative. The debt requested covers the equipment only — 369 000 ₪ of balloon loan pledged on the van and the two aircraft — plus a 100 000 ₪ overdraft facility, which stays there as a safety net and costs nothing as long as it is not drawn.

8.1A light structure, and what it changes

We are not setting up a conventional company. The office already exists, the website and the CRM are built in-house, the vehicle and the drones are financed by balloon loan rather than bought outright, and the pilot is recruited already licensed rather than trained for five months at our expense. The field pair comes in mid-month two and produces pressure washing from month three, four months before the first commercial flight.

69 707 ₪
Fixed costs · 1 crew · per month
79 212 ₪
Break-even
90 654 ₪
Monthly ceiling · 1 crew
369 k₪
Equipment financing requested
A single crew clears its break-even, but only just. Seventeen production days a month, a façade job that consumes 1.84 of them: the ceiling is 9.2 jobs, or 90 654 ₪. Against 79 212 ₪ of break-even, the margin at saturation is 10 069 ₪ a month. The project funds its own operations and borrows only for its equipment, but it produces a comfortable margin only with two crews — or at a rate above 900 m² a day. We do not present it any other way.

8.1bThe 69 707 ₪ of fixed costs, line by line

This is the denominator of the break-even: it has to be verifiable line by line. Single-crew cruising speed, from month eight onwards, administrator not recruited.

Item Monthly amount From month
Drone pilot and crew leader — fully loaded employer cost 28 800 ₪ 2
Field sales engineer — fully loaded employer cost 14 400 ₪ 4
Phone sales rep — legal floor, loaded, excluding commissions 7 740 ₪ 8
Balloon loan on the two aircraft 3 547 ₪ 3
Balloon loan on the van 3 320 ₪ 3
Insurance — aviation third-party liability, hull damage, fleet, premises 5 000 ₪ 5
Office, telecoms, software licences, sundries 4 500 ₪ 1
Accountant and management fees 900 ₪ 2
Recurring marketing, excluding the launch budget 1 500 ₪ 3
Total at cruising speed 69 707 ₪ 8
Bilingual administrator — not recruited in this scenario + 12 000 ₪ 18
Second field pair — not recruited in this scenario + 28 800 ₪ 16
What these 69 707 ₪ do not yet contain, and what has to be costed before the bank. The Civil Aviation Authority taxes and fees for filing the authorisation, for registration and for the examinations — asked of the lawyer in question B5, with no order of magnitude to date. A provision for bad debt, given that we collect 60% of the price at sixty days from building committees. The cost of site water, drawn from the building’s water point: nobody has yet said who pays for it, or what we do if the flow is not enough. And the employer on-costs coefficient set at 1.20: once pension provision, הבראה (recreation allowance), holidays and the פיצויים (severance) provision are added up, it can rise to 1.28-1.30. With a chargeable base of 42 450 ₪, that adds 3 400 to 4 250 ₪ of fixed costs a month and takes the break-even to 83 100 to 83 900 ₪. A scenario to be costed by the accountant before the bank meeting.

8.2The assumptions

Assumption Value Justification
Production days per month 17 Twenty working days, less wind, rain and flight restrictions
Duration of a façade job 1.84 days Weighted average of the price list, at 900 m² washed per day
Average façade ticket 9 812 ₪ Weighted average of the size mix — section 12.1
Pressure washing day 4 000 ₪ Our current trade, known rate
Pressure washing, from month 3 17 days The pair is assigned to it full time for as long as the drone is not flying
Seasonality −25% From November to March, on drone activity only
Deposit on order 40% Balance collected at sixty days
Variable costs 12% Water, consumables, fuel, wear
Date the authorisation is obtained Month 7 The only assumption we do not control. Sensitivity in § 8.6

8.3The investment

The drones and the van are financed by balloon loan pledged in favour of the lender — the pledge is worth about four points of interest. The rest is paid out of cash. To this is added an inflow of 44 085 ₪ of input VAT credit recovered on the van in month three.

Item Value Equity Financed Month
Two drones under 25 kg, delivered Israel 270 000 ₪ 100 000 ₪ 170 000 ₪ 2
Ford Transit 399L — gross vehicle weight 3 990 kg 289 000 ₪ 90 000 ₪ 199 000 ₪ 2
Site survey vehicle, second-hand 45 000 ₪ 45 000 ₪ — cash 1
Production equipment — tank, reverse-osmosis unit, generator 40 000 ₪ 40 000 ₪ — cash 2
Ground-level pressure washing equipment 60 000 ₪ 60 000 ₪ — cash 2
Racking and wrap for the two vehicles 25 000 ₪ 25 000 ₪ — cash 4
Total 729 000 ₪ 360 000 ₪ 369 000 ₪

The balloon loan comes to 6 866 ₪ a month — 3 547 ₪ for the two aircraft, 3 320 ₪ for the van — over forty-eight months, calculated at 8% nominal annual, with 86 700 ₪ and 34 000 ₪ of final balloon payments. Over the full term, this financing costs 81 287 ₪ in interest: 47 000 on the van, 34 300 on the aircraft. Obtained at 6.5%, it would fall to 65 700 ₪; at the rate of 5.326% recorded on a pledged new vehicle, to 53 650 ₪ — that is 27 600 ₪ saved — and it is what the first question put to the bank is about. To this are added 91 000 ₪ of start-up costs (lawyer and incorporation 25 000, regulatory consultant 60 000, website and CRM 6 000) and 72 000 ₪ of marketing spread over the first six months, peaking in month three when the campaign is launched.

One hundred and seventy thousand shekels cannot be financed. A tank, a reverse-osmosis unit, a generator, a pump: no lender will take that as security. A balloon loan wants a registered vehicle or a drone identifiable by serial number. That is what makes month two the heaviest of the plan.

8.4The cash plan — one crew

Founders’ equity contribution of 600 000 ₪, 369 000 ₪ of equipment financed by balloon loan, no working capital loan, authorisation obtained in month seven. The administrator is not recruited in this version: the partners hold flight coordination themselves.

Month Pressure washing Drone Revenue Cash position
1 507 500 ₪
2 185 700 ₪
3 68 000 ₪ 68 000 ₪ 126 259 ₪
6 68 000 ₪ 68 000 ₪ 31 079 ₪
7 45 920 ₪ 29 436 ₪ 75 356 ₪ 31 013 ₪
9 16 480 ₪ 68 684 ₪ 85 164 ₪ 23 932 ₪ — cash trough
12 90 654 ₪ 90 654 ₪ 43 015 ₪
18 84 991 ₪ 84 991 ₪ 85 308 ₪
24 90 654 ₪ 90 654 ₪ 138 928 ₪
36 90 654 ₪ 90 654 ₪ 234 842 ₪
The cash position never turns negative. Cash trough at 23 932 ₪ in month nine, rising steadily after that. Revenue: 782 931 ₪ in year 1, 1 059 534 ₪ in year 2 and in year 3. Start-up and operations are covered by the equity contribution; the debt is limited to the financing of the equipment, 369 000 ₪ secured on the assets themselves.

The drone ramp-up depends on the overdraft facility. The model assumes three jobs in the first month of authorisation, five in the second, seven in the third. That ramp only holds if the 100 000 ₪ facility can be drawn from the day the account is opened. If the bank makes it conditional on a first set of closed accounts, we drop back to two, four then six jobs: the month-nine trough falls from 23 932 ₪ to a range of 5 000 to 12 000 ₪ — positive, but with no cushion. That is the subject of question B2 put to the bank, and its answer decides which of the two versions we present.

But the trough stays thin. 23 932 ₪ is ten days of costs. Pressure washing has to run seventeen days a month from month three to month six — it is what holds the cash position while the file is being examined. The 100 000 ₪ overdraft facility covers that gap and costs nothing as long as it is not drawn.

Figures to be confirmed by the accountant.

8.4bThe month-by-month detail, from M1 to M12

The 23 932 ₪ trough only stands if it can be rebuilt. Here is the line by line of the first twelve months, in the scenario adopted: drone authorisation in month seven, a single crew, a rate of 900 m² per day. Cash collected follows the 40% on order, 60% at sixty days convention; variable costs are 12% of invoiced revenue; the balloon loan line is kept separate from the other fixed costs so the bank can read its own instalment.

Month Pressure washing invoiced Drone invoiced Cash collected Fixed costs Balloon loan Variable costs Investment and marketing VAT End-of-month balance
M1 4 500 ₪ 88 000 ₪ 507 500 ₪
M2 19 800 ₪ 302 000 ₪ 185 700 ₪
M3 68 000 ₪ 27 200 ₪ 35 700 ₪ 6 866 ₪ 8 160 ₪ 80 000 ₪ 44 085 ₪ 126 259 ₪
M4 68 000 ₪ 27 200 ₪ 50 100 ₪ 6 866 ₪ 8 160 ₪ 37 000 ₪ 51 332 ₪
M5 68 000 ₪ 68 000 ₪ 55 100 ₪ 6 866 ₪ 8 160 ₪ 8 000 ₪ 41 206 ₪
M6 68 000 ₪ 68 000 ₪ 55 100 ₪ 6 866 ₪ 8 160 ₪ 8 000 ₪ 31 079 ₪
M7 45 920 ₪ 29 436 ₪ 70 942 ₪ 55 100 ₪ 6 866 ₪ 9 043 ₪ 31 013 ₪
M8 31 200 ₪ 49 060 ₪ 72 904 ₪ 62 840 ₪ 6 866 ₪ 9 631 ₪ 24 579 ₪
M9 16 480 ₪ 68 684 ₪ 79 279 ₪ 62 840 ₪ 6 866 ₪ 10 220 ₪ 23 932 ₪
M10 5 440 ₪ 83 402 ₪ 83 693 ₪ 62 840 ₪ 6 866 ₪ 10 661 ₪ 27 258 ₪
M11 90 654 ₪ 87 360 ₪ 62 840 ₪ 6 866 ₪ 10 879 ₪ 34 033 ₪
M12 90 654 ₪ 89 567 ₪ 62 840 ₪ 6 866 ₪ 10 879 ₪ 43 015 ₪
Three things can be read in this table, and only one of them is a risk. The balance falls from 600 000 to 185 700 ₪ as early as month two: that is the investment, not a loss. It touches 31 079 ₪ in month six — the last month without the drone — then 23 932 ₪ in month nine, which is the real trough, the time it takes for the sixty-day lag to clear on invoicing that is rising. From month ten the curve climbs again with nothing changed in the model.
What this table assumes and what has to be confirmed. The VAT refund of 44 085 ₪ is booked in month three: that is the most favourable convention, and it depends on the filing regime chosen — monthly or bi-monthly — and on the tax authority’s actual processing time. Delayed by two months, it brings the month-four balance down to 7 247 ₪, which then becomes the trough of the year: that is the first reason for the overdraft facility, before even the month-nine dip. A question put to the accountant. The 40% on order also assumes that the ועד בית (building committee) accepts the deposit; with no deposit, everything at sixty days, the cash position goes below zero from month four and falls to −42 345 ₪ in month ten — the overdraft facility would become structural and no longer temporary. The deposit is therefore not a commercial convenience, it is a condition of the plan.

8.5The second crew: what it changes

It is not a date in the timeline but a decision, taken on the triggers in § 8.7. Here is what it produces in the tightest case — triggered at the earliest, in month fourteen, with the administrator following in month eighteen. The timeline in section 10 has it operational in month sixteen; two months later, the hole is smaller.

One crew Two crews from month 14
Cash trough +23 932 ₪ in month 9 −56 985 ₪ in month 12
Revenue year 1 782 931 ₪ 782 931 ₪
Revenue year 2 1 059 534 ₪ 2 028 414 ₪
Revenue year 3 1 059 534 ₪ 2 119 068 ₪
Cash position in month 36 234 842 ₪ 920 661 ₪
Fixed costs at cruising speed 69 707 ₪ 110 500 ₪
The second crew doubles revenue, but it digs a hole of 57 000 ₪ in month twelve. It requires 100 000 ₪ of equity for the third aircraft, two salaries before the jobs follow, and it arrives just before the winter dip. That is exactly what the 100 000 ₪ overdraft facility is for — it covers the hole, it is repaid in month sixteen, and it does not turn the project into a debt case.

8.6What everything depends on

Two parameters drive the outcome, and only one is within our control.

Date of the authorisation Cash trough Cash position month 36 Revenue year 1
Month 7 — assumption adopted +23 932 ₪ 234 842 ₪ 782 931 ₪
Month 9 +4 199 ₪ 194 970 ₪ 737 622 ₪
Month 12 −26 601 ₪ 136 769 ₪ 687 356 ₪
Month 15 −58 677 ₪ 87 598 ₪ 680 000 ₪
Washing rate Jobs per month Cash trough Cash position month 36
600 m² per day 6.7 −290 838 ₪ −290 838 ₪
750 m² per day 8.0 −17 968 ₪ −17 968 ₪
900 m² per day — adopted 9.2 +23 932 ₪ 234 842 ₪
1 100 m² per day 10.7 +26 860 ₪ 539 421 ₪
1 300 m² per day 12.1 +28 439 ₪ 810 284 ₪
A delay in the authorisation costs cash, the rate decides viability. Eight months of delay on the authorisation move the trough from +24 000 to −59 000 ₪: it is awkward, it is absorbed by the overdraft facility, and it does not change the cruising regime. A rate of 600 m² per day, on the other hand, makes the model unviable — the crew loses 11 916 ₪ a month at saturation, and the break-even sits at around 760 m² per day. That is the first figure to measure on the first three jobs, stopwatch in hand.

8.7The triggers for the second crew

The second crew is not a date in the timeline, it is a conditional decision. Three conditions have to be met at the same time, measured over the two preceding months.

Trigger Threshold What it checks
The workload ≥ 14 of the 17 production days booked, two months running 82% saturation. Expressed in days and not in number of jobs, this threshold stays true whatever the drone’s actual rate
The order book > 5 weeks between signature and the job We are making our clients wait or, worse, we are turning jobs down
The cash position ≥ 200 000 ₪ available, overdraft facility not drawn Enough to absorb the 100 000 ₪ of equity for the third aircraft and two salaries before the jobs follow
Consistency check Conversion rate stable If the order book lengthens and conversion falls, the saturation is an artefact of slow selling, not of demand
And if the triggers never occur? We stay with one crew, and nothing happens: no extra commitment to unwind, and the equipment already financed keeps running. That is the whole point of growth that is decided rather than endured. At seven jobs a month we are already above our break-even, and the cash position rises steadily to 234 842 ₪ in month thirty-six.

9The risks

9.1Summary table

Risk Severity Our answer
Refusal or delay of the special operating authorisation Critical Consultant engaged before any purchase; membership of the trade organisation; fallback on ground-level pressure washing, solar and isolated industrial sites, which require no flight waiver
Sales volume below plan Critical The heavy drone of month 20 postponed, a decision taken after the month 18 review; the second crew postponed, which saves 28 800 ₪ of costs a month; the cautious scenario stays positive with no additional financing
Flight ban for security reasons High Postponement clause in every contract; the crew switches to ground-level pressure washing the same day
Drone above 25 kg when loaded High Loaded weight contractually agreed with the supplier before ordering; a question put to the lawyer
Damage to a client — window, water ingress, façade High Dedicated insurance; photographic condition report before every job; contractual liability cap
The pilot leaving with his licence High A wide Israeli pool — the army trains a large number of operators every year; a fixed-term commitment with a loyalty bonus; a second licensed pilot recruited with the second crew, and the partners take the licence themselves once the legal framework is settled
Complaint from a resident over invasion of privacy Medium Written agreement from the property management company and a notice to residents before every job; camera limited to what flying strictly requires
Breakdown or loss of an aircraft Medium Stock of wear parts and batteries; second aircraft available from month two; machinery breakdown insurance
A competitor entering the residential market Medium A six to nine month head start on the authorisation; framework agreements with property management companies; local reputation built through video
Winter seasonality Low Pressure washing days doubled from November to March

9.2The risk we consider the most serious

It is neither the drone, nor the regulations, nor the weather. It is filling the schedule. Our model requires about one hundred and fifty qualified leads a month for one crew, twice that for two. No Israeli drone operator has shown that this volume can be reached in the residential market — which is both our opportunity and our main risk.

We handle it with three levers that are measurable from the first quarter of trading: the number of qualified leads generated, the conversion rate on quotes, and the share of revenue signed with property management companies, offices or solar — the only channels where recurring revenue exists. If those three indicators fall away in month twelve, the second crew is postponed — which preserves 28 800 ₪ of costs a month and makes the cautious scenario sustainable.

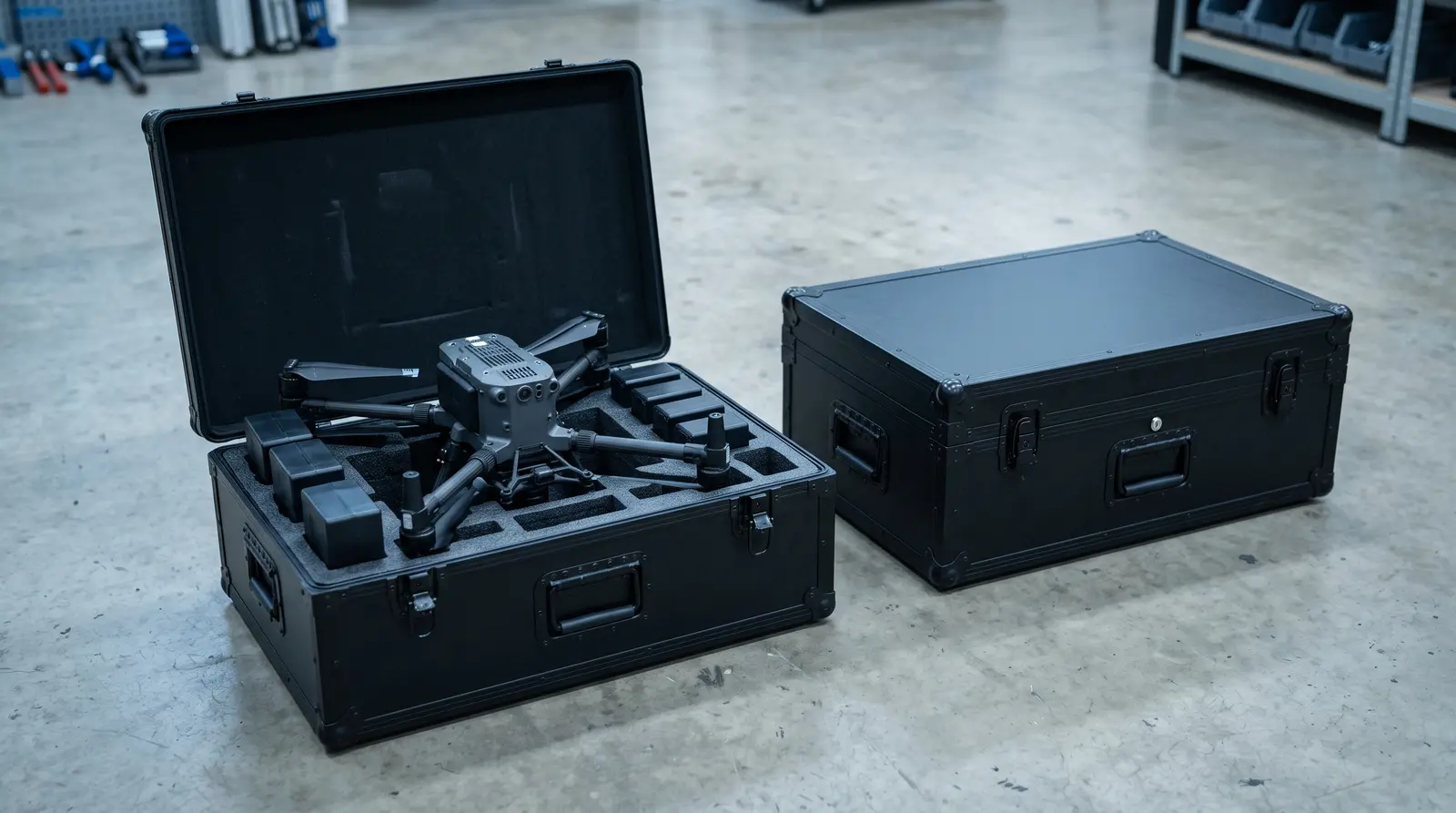

The two drone transport cases, one of them openאוסמוז

9.3What remains to be confirmed

  • The minimum insurance cover required by the commercial air regulations.
  • The scale of penalties applicable to a non-compliant flight, and the extent of the directors’ personal liability.
  • Written confirmation from the authority that a single special operating authorisation covers all our job sites.
  • Confirmation of the loaded weight of the aircraft against the 25 kg threshold.

These four points are the subject of the questionnaire handed to the lawyer, at the end of the dossier.

10The trajectory

10.1The milestones

Month Milestone Success indicator
1–2 Company incorporated, van and aircraft ordered, field pair recruited and in post by the middle of month 2, authorisation file opened with the consultant — filed in month 3 Full crew and equipment delivered by the end of month 2
3 Ground-level pressure washing in production, website and campaign launched at T+90 First revenue in month 3
4–6 First qualified building committee leads, quotes issued, order book built, file processed by the authority Order book filled before the first flight
on authorisation First billable drone job — the only unknown in the timeline Conversion of the order book already built
10–12 Ramp-up of offer A, first property management framework agreements signed 9 jobs a month in month 12, which is saturation for one crew
13–16 Third aircraft in month 14 and recruitment of the second crew, on measured triggers Second crew operational in month 16
17–24 Two crews at cruising speed, opening of the recurring channels outside residential First framework agreements signed with property management companies
25–36 Consolidation, geographic expansion, preparation of a third crew Cash position above three months of costs

10.2The natural extensions

The same aircraft, the same crew and the same authorisation open several adjacent markets that we do not include in the financial forecast — they are the potential, not the promise.

  • Solar panels. A dirty photovoltaic field loses 15 to 25% of its output. The cleaning sells on a calculable return on investment, which makes it the easiest sale of all.
  • Thermographic façade inspection. A thermal camera on the same drone detects thermal bridges and water ingress. It is a high-margin expert service, sold to the same property management companies, with a report at the end.
  • Anti-moss and water-repellent treatment. Extends the effect of the cleaning and doubles the value of the job.
  • Pigeon removal and fitting of bird-deterrent devices, sold as an add-on by the traditional Israeli operators.

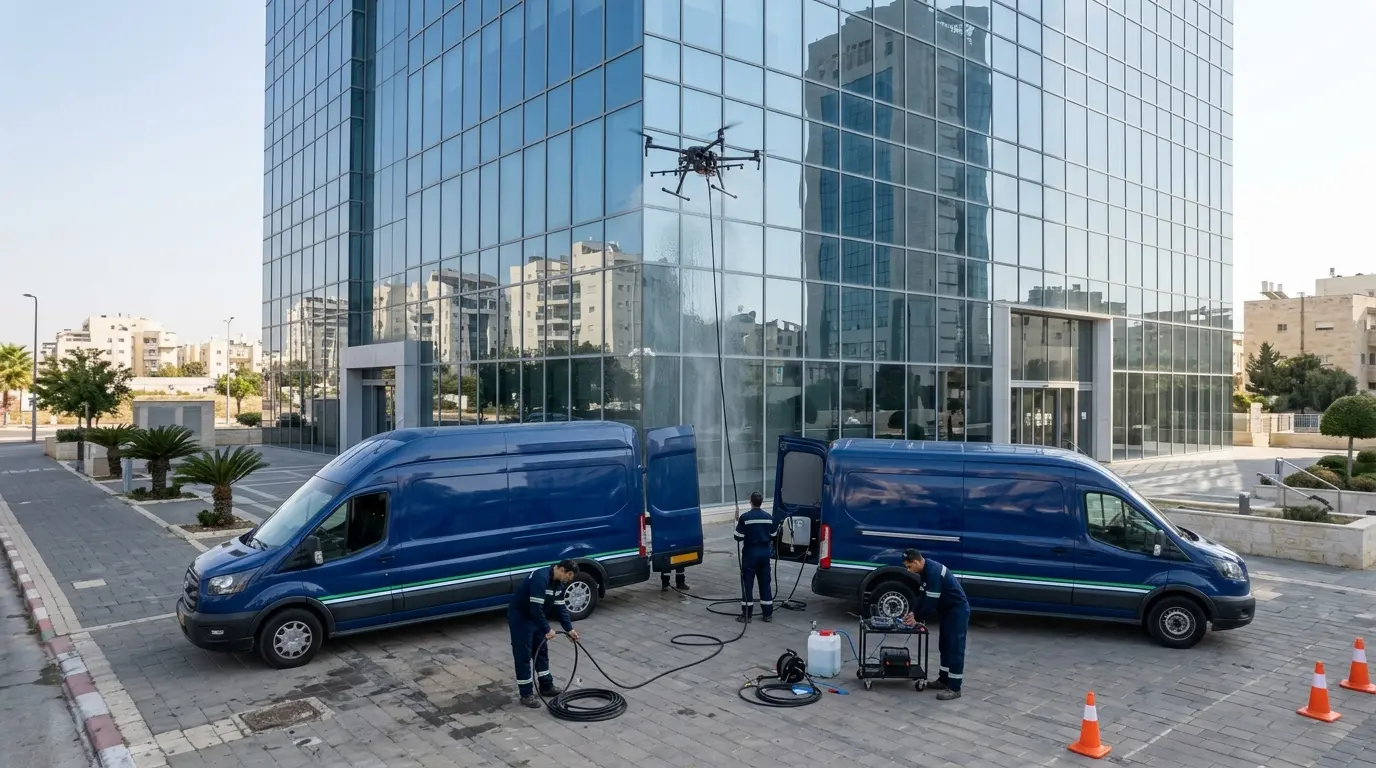

Two crews and two vans in front of an office towerאוסמוז

10.3The company at five years

Three field crews, coverage of the centre and the coast, a portfolio of property management companies under annual contract, and a reference position in a segment nobody occupies today. The value will not be in the drones, which are replaced every four years: it will be in the operating authorisation, the portfolio of recurring contracts and the brand.

11The equipment

What we buy and what it costs. The purchasing reasoning — models compared, options ruled out, prices recorded — is in the Explanations, so that this dossier stays readable.

11.1The droneExplanations

Two aircraft under 25 kg, from two different makes: the Hercules 10 Tethered Spray and the DJI Matrice 400 fitted with a cleaning kit. Both are fed with water by a hose from the ground: the pump and the tank stay on the pavement, the aircraft carries only the nozzle bar. The 25 kg threshold is the line not to cross — beyond it, operations fall under the 1981 regulation, written for manned aviation.

Delivered cost of the first aircraft: 118 000 to 133 000 ₪, based on the only pack whose price is published — 26 850 € excluding VAT. The order is conditional on that price: above 135 000 ₪ delivered, we switch to the second Matrice 400. A heavier high-pressure configuration exists in the catalogue at 46 850 €: it would cost about 70 000 ₪ more per aircraft, and that gap could not be absorbed without a trade-off — it is the first thing to have the supplier confirm in writing. Customs duty and purchase tax nil until May 2028, import VAT recoverable.

The blocking point on import is not customs, it is the Ministry of Communications. A spectrum authorisation — אישור תקשורת 1301 — is mandatory before the goods arrive. Without it, the equipment is impounded and a fine follows. To be started at the same time as the order, not after.

11.2The vehicleExplanations

A panel van above 3.5 tonnes, and not a pickup: Ford Transit 399L, 289 000 ₪, 1 714 kg of payload, 12.4 m³. Three reasons that add up. Above 3 500 kg the VAT becomes recoverable and the costs deductible at 100% instead of 45%. The enclosed volume goes from 1.18 m³ under a hardtop to 12.4 m³, and the drone travels sheltered, dry and locked. And the payload absorbs the 930 kg of equipment with 784 kg to spare. Real cost over five years: 208 508 ₪, that is 82 000 to 86 000 ₪ less than the pickup.
The van with all its doors open, the full fit-out visibleאוסמוז

The second vehicle, for site surveys, is a second-hand van from 2018-2020 bought for cash between 35 000 and 55 000 ₪. It carries nothing heavy: buying new makes no sense here.

11.3Pressure washing, our first trade

The same van serves two trades, and the second is not an accessory to the first. Tank, reverse-osmosis unit, generator, pump and hose reels feed the drone in flight and the ground-level cleaning work. Drain jetting and drain maintenance have been David’s trade for twelve years: we already know how to sell it, deliver it and invoice it. It is what keeps the company alive from the third to the seventh month, while the flight file is being processed, and it is what fills the days when the wind grounds the aircraft.

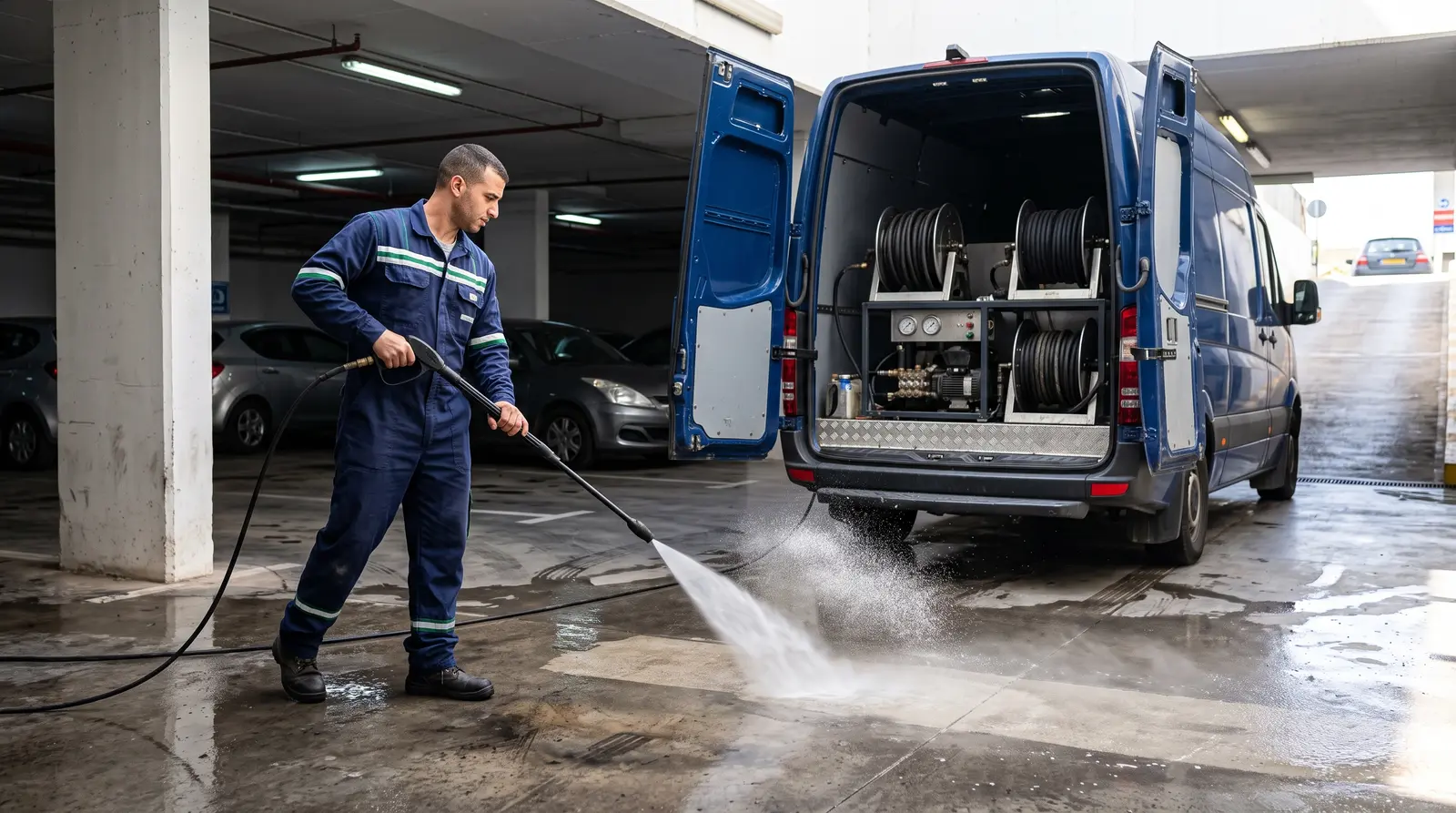

Pressure washing an underground car parkאוסמוז
Equipment investment Amount Month
400 L tank, reverse-osmosis unit, generator, pump, hose reels, PPE, safety marking 40 000 ₪ 2
Additional high-pressure kit for the ground-level business 60 000 ₪ 2
Van racking and fit-out, and wrap for both vehicles 25 000 ₪ 4

12The price list

What we sell at, how that price is built, and what it produces in the financial forecast.

12.1Prices by building sizeExplanations

Prices including VAT, full façade, washed with osmosis water. The Israeli market sits between 5.5 and 10 ₪ per square metre; we are in the middle of that band, never below it.

Size Price incl. VAT Per flat Time on site
4 storeys 5 600 ₪ 700 ₪ 1 day
6 storeys 7 700 ₪ 642 ₪ 1.5 days
8 storeys 9 700 ₪ 606 ₪ 2 days
12 storeys 17 100 ₪ 712 ₪ 3 days
15 storeys 22 500 ₪ 750 ₪ 4 days
20 storeys 31 400 ₪ 785 ₪ 5.5 days
Ground-level pressure washing 4 000 ₪ per day

On top come the market’s customary surcharges, taken from the only scale published in Israel: seaside +20%, heavy soiling +15 to 30%, urgent job within fifteen days +20%. And two discounts that serve our schedule rather than the rebate: a second adjoining building on the same day −10%, off-season signature −10%.

An annual clean would represent 50 to 62% of a building’s running budget. That cannot be voted through, and it has to be said before the client works it out. The affordable frequency is one pass every two to three years, and that is exactly what rope access technicians recommend on technical grounds. The reserve fund would need five to seven years of saving: the expense therefore goes through a residents’ meeting vote, and payment in three or four instalments is offered from the outset, not in answer to a price objection.
The three quoting rules. The floor is a daily price, not a per-job price: never below 4 800 ₪ per day mobilised, travel and set-up included. The measurement comes before the price: a 10% error on the surveyed area is 10% of margin. And the way the price is shown follows the channel: including VAT to a ועד בית, which cannot reclaim VAT, excluding VAT to a property management company, which can, and which will see us as 18% cheaper at the same real price.

12.2What the price list changes in the forecast

9 812 ₪
Weighted average ticket
9.2 a month
Jobs at saturation, not 22
90 654 ₪
Real monthly ceiling for one crew
79 212 ₪
Break-even
Activity for the month Days used Revenue Margin after costs
5 jobs + 7.8 days of pressure washing 17 80 260 ₪ + 923 ₪
6 jobs + 6 days of pressure washing 17 82 712 ₪ + 3 081 ₪
7 jobs + 4.1 days of pressure washing 17 85 164 ₪ + 5 238 ₪
9.2 jobs, saturation 17 90 654 ₪ + 10 069 ₪
Two crews at saturation, administrator included 34 181 309 ₪ + 49 046 ₪
What this really changes. A single crew clears its break-even, but only just: between +900 and +10 100 ₪ a month depending on how full the schedule is, as long as the administrator is not hired — that post costs 12 000 ₪ more a month and is only decided on together with the second crew. The project stays sound — cash never negative, debt limited to the equipment — but it produces comfortable margin only with two crews, or at a rate above 900 m² a day. The commercial conclusion is unchanged: nine mid-sized deals a month rather than twenty-two small ones, so half as many contacts, flight coordinations and paperwork.

Hence the decisive importance of the rate. At 750 m² a day the margin vanishes — minus 500 ₪. At 600, the crew loses 11 900 ₪ a month. At 1 100, it earns 22 900. No other parameter in this dossier has that amplitude, and it is measured on the first three jobs.

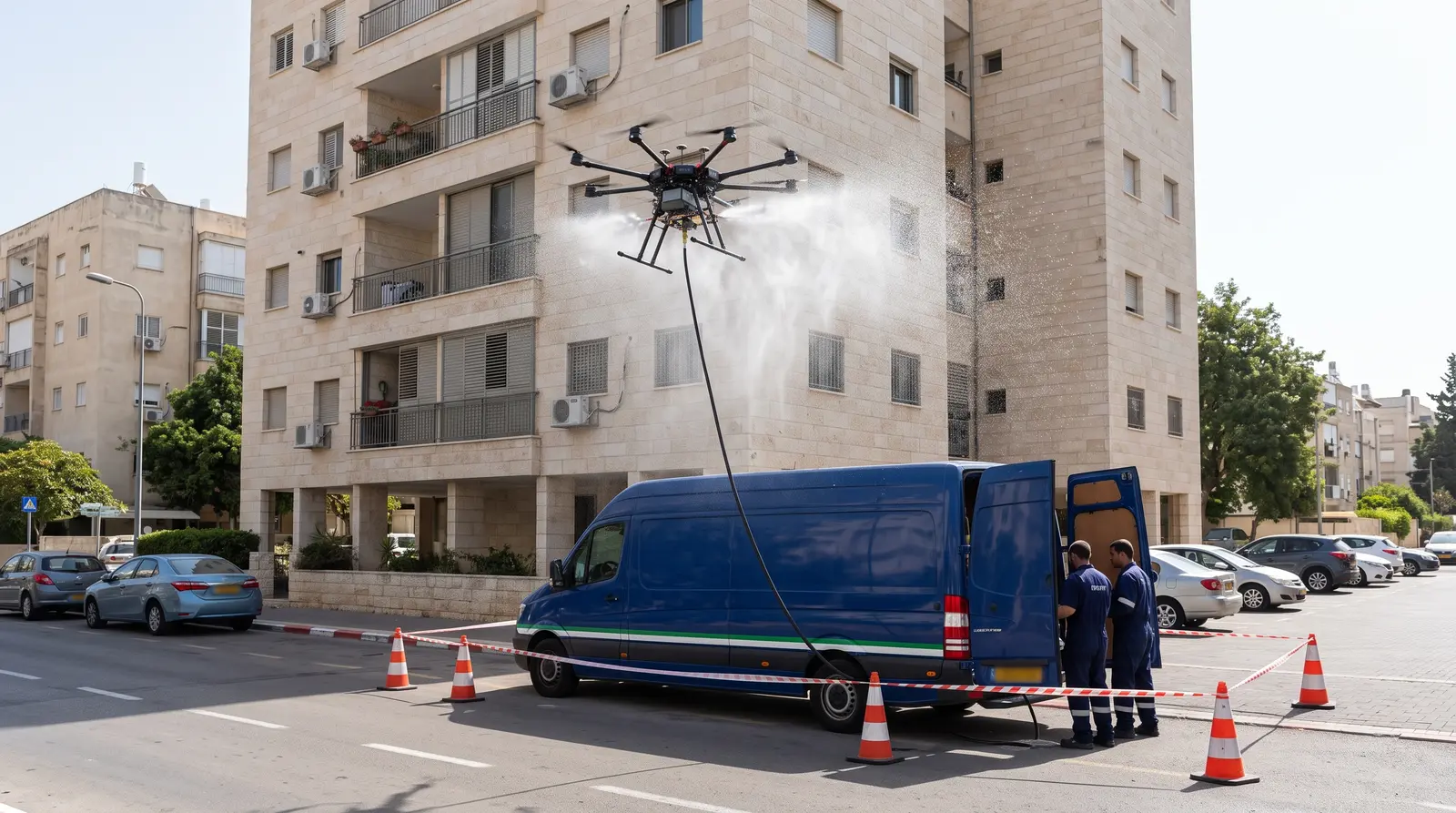

The drone in flight, the hose running down to the van on the groundאוסמוז

§Sources and references

·Regulation

·Market and competition

·Employment and tax

Methodological caveat. The regulatory data come from desk research carried out on 25 August 2026, based on the official text published in the statute book. The consolidated Nevo text and the 2011 Aviation Law could not be consulted directly. The salary, employer on-cost and net pay figures are orders of magnitude, to be confirmed by the project accountant. The selling prices come from published rates recorded from Israeli providers, and will have to be validated against real competing quotes.

The market

Decisions and positions taken

Question Position taken
Which segment Multi-unit residential of 4 to 15 storeys, and not industry. All five Israeli drone operators target Intel, the Israel Electric Corporation and Dead Sea Works. None has a verifiable residential reference
Which cities first Bat Yam, Ashdod, Netanya. Vertical density and salt corrosion in the same place. A coastal façade degrades in 2 to 3 years against 10 inland
Against whom Against the boom lift, not against the rope access technician. The boom lift is already 20 to 30% cheaper than rope access on 4 to 6 storeys — that is what has to be beaten
On what Not on price. On the street left clear, on the absence of drilled anchors, on half the time on site, and on the photo report handed to the property management company
The pilot Recruited already licensed, never trained in-house. Five months of salary saved, and no funded licence that can walk out with its holder
The bet, stated plainly. The spend is 100% discretionary: no Israeli law requires a façade to be cleaned. It is voted at a residents’ meeting. Our thesis is that the failure of the incumbent operators in residential is a problem of sales organisation, not of market.
Not consolidated. The exact number of buildings run by a building committee is the subject of no official publication. Our working range — 100 000 to 180 000 — is inferred from the share of homes in multi-unit buildings. No financial projection rests on it.
The market price survey
Method Observed price Constraints
Rope access, per day 3 000 to 3 500 ₪ · 3 300 to 5 900 ₪ for façade and glazing +15 to 25% above the 11th storey, +25 to 40% above the 20th, +20% in the coastal strip, +20% at night
Flat rate, 6 to 8 storeys 6 000 to 15 000 ₪ The only flat rate published anywhere on the Israeli market
Boom lift with operator 2 500 to 4 000 ₪ a day · 500 to 1 200 ₪ an hour depending on height 20 to 30% cheaper than rope access up to 6 storeys, but a highway permit is required
Boom lift, bare rental 80 to 1 000 ₪ a day + 250 to 600 ₪ of transport No operator, rate tapers on long hire
Pressure washing, published price 15 ₪/m², tapering from 2 to 30 Only one provider publishes a price per m² in Israel
Office glazing 200 to 500 ₪ per window The most recurring and the best-paid segment
Solar panels in residential buildings 700 to 1 300 ₪ per visit Two-visit subscription 1 200 to 1 800 ₪/year, 10 to 20% discount
Who decides, who pays

The budget is voted at a general meeting. Typical running budget of a twenty-flat building: 24 200 ₪ a year, that is about 101 ₪ per flat per month, including a reserve fund of about 2 200 ₪. A façade clean at 6 000-15 000 ₪ therefore represents 25 to 60% of the annual running budget — the spend never goes through as running cost.

The fast decision-maker is not the volunteer ועד בית, it is the property management company on the buildings it runs under mandate, and the facility manager on the office side. The E-DRONE × Electra FM partnership validates exactly that channel.

The housing stock

2.96 million homes, +61 200 a year. In 2024, 47.5% of new homes were in buildings of nine storeys or more. Towers of 16 storeys and above started in 2023: Bat Yam 1 486, Ashdod 732, Lod 697, Netanya 694, Rishon LeZion 651, Tel Aviv 426.

No legal cleaning obligation in Israel, unlike the French façade-renovation rule. The spend is 100% discretionary. What does exist concerns structural safety, not cosmetic maintenance.

The solution

Decisions and positions taken

Question Position taken
Which aircraft Two aircraft under 25 kg, from two different makes. The Hercules 10 Tethered Spray and the DJI Matrice 400 with a cleaning kit
Why two makes The cleaning-drone market is young. Six months of side-by-side operation teach more than a year of spec sheets. Whichever model holds up becomes the standard for the second crew
Water supply A hose from the ground. A façade consumes hundreds of litres, and a tonne of water does not fly. The payload capacity therefore does not need to be huge
Red line 25 kg at take-off, payload included. Above that, operations fall under the 1981 regulation, written for manned aviation
The trap avoided. The Hercules 20 was our first choice. Its sales page states a European certification capped at 25 kg; the same manufacturer’s spec sheet gives an MTOW of 33 kg. Both cannot be true. We changed aircraft.
What the mass constraint rules out
Aircraft Mass Verdict
DJI Agras T25 32 kg Ruled out — 25.4 kg empty
DJI Agras T50 52 kg Ruled out
DJI Agras T100 75 to 90 kg Ruled out
XAG V40 / P100 / P150 28 to 51 kg Ruled out
Aerones 55 kg Ruled out, and not sold here
Drone Volt Hercules 20 MTOW 33 kg Ruled out — 8 kg too heavy
Hercules 10 Tethered MTOW 20 kg Selected
DJI Matrice 400 MTOW 15.8 kg Selected
A naming trap. At DJI, the number after the T is the tank volume in litres, not the mass. The T25 weighs 32 kg with its battery. A supplier can offer it to you in good faith and be wrong.

The business model

Decisions and positions taken

Question Position taken
Unit of account The crew day, not the number of jobs. A four-storey block and a tower share neither price, nor duration, nor margin
Price positioning In the middle of the market band, 5.2 to 7.5 ₪ per m², never below. The market sits between 5.5 and 10
Absolute floor 4 800 ₪ per day mobilised. A one-day job at 4 200 ₪ is not a thin margin, it is a loss
Renewal cycle One pass every two to three years in residential. An annual pass would represent 50 to 62% of a building’s running budget — unvotable
Where the recurrence is Not in residential. In solar panels, offices and property management companies
The most fragile figure: the rate. We assume 900 m² washed per day and nobody publishes that figure. Between 600 and 900 m² a day, the crew moves from −11 916 ₪ to +10 069 ₪ a month, and break-even sits at about 760 m² a day: it is the only parameter in the dossier that changes the sign of the margin. To be measured stopwatch in hand on the first three jobs.
The base price list, incl. VAT
Size Façade Price Per flat Time on site
4 storeys 744 m² 5 600 ₪ 700 ₪ 1 day
6 storeys 1 188 m² 7 700 ₪ 642 ₪ 1.5 days
8 storeys 1 680 m² 9 700 ₪ 606 ₪ 2 days
12 storeys 2 736 m² 17 100 ₪ 712 ₪ 3 days
15 storeys 3 600 m² 22 500 ₪ 750 ₪ 4 days
20 storeys 5 040 m² 31 400 ₪ 785 ₪ 5.5 days
What the building committee can actually vote
Size Per flat 1× a year 1× / 2 years 1× / 3 years
4 storeys 700 ₪ 58% of the budget 29% 19%
6 storeys 642 ₪ 53% 26% 18%
8 storeys 606 ₪ 50% 25% 17%
15 storeys 750 ₪ 62% 31% 21%

An annual clean would raise the service charges by 50 to 62%. That cannot be voted through. Every two to three years, it falls back to 17-31% — and that is exactly the frequency rope access technicians recommend on technical grounds. The reserve fund, for its part, would need five to seven years of saving, hence the payment in three or four instalments offered from the outset.

Surcharges and discounts

Storeys 11 to 20 +15 to 25% · above the 20th +25 to 40% · seaside +20% · heavy soiling +15 to 30% · urgent job within fifteen days +20%. A second adjoining building on the same day −10% · off-season signature −10% · a committed two-pass contract −15%, reserved for the channels where recurrence can be voted: solar, offices, property management companies.

Where a subscription works
Channel Frequency Format
Residential building 1× / 2-3 years No subscription — a general-meeting vote, no VAT to reclaim
Solar panels in residential buildings 2× / year Subscription — 10 ₪ per flat per month, votable
Property management company depends on the portfolio Framework contract — decided without a general meeting
Offices, facility 3 to 4× / year Subscription — operating budget
Shops, shopfronts monthly Subscription
Including or excluding VAT, depending on the channel. A ועד בית is not VAT-registered and reclaims no VAT: we show it prices including VAT, otherwise the 18% surprise lands at the end of the negotiation. A property management company reclaims it: we show it prices excluding VAT and appear 18% cheaper at the same real price.

The regulatory barrier

Decisions and positions taken

Question Position taken
Applicable text תקנות הטיס (הפעלת מערכת כטב״ם קטן), התשפ״ד-2024, in force since 11.08.2024
What blocks us תקנה 32(א)(2) imposes a minimum distance equal to the greater of the flight height or 50 metres. Cleaning an occupied façade is therefore impossible under the standard regime
The way out הרשאה להפעלה מיוחדת, תקנות 37-43. Granted on the quality of a risk management plan, revocable, non-transferable
Municipalities No municipal flight authorisation. Civil aviation is an exclusively national competence. Only the work at ground level falls to the town hall — and the drone escapes it most of the time
Lead time per job Seven working days of coordination with מודיעין טיס, structurally incompressible. Hence a commercial promise at ten days
It is a barrier, not an obstacle. The authorisation takes months and has to be earned on file. Once obtained, it cannot be bought — that is precisely what protects the position against a better-capitalised competitor. And document management has been our trade for ten years.
What the authorisation implies
Feature What it means for us
Granted to an operator, not to a mission A single authorisation would cover the whole activity — to be confirmed in writing
Risk management plan, תקנה 38 Design and drafting work, not a counter formality
Proof of competence, תקנות 39-40 A further theory or practical examination is possible for our pilots
Conditions imposed: headcount, scope, duration, area Our internal procedures must be written before they can be authorised
Suspension of up to one year, appeal within 30 days, תקנה 43 Day-to-day compliance becomes an asset to protect
We file the first applications ourselves

As soon as the drones are delivered, the partners personally fly the first tests and file the first coordinations, before any administrative hire. First, because you do not write a procedure you have never carried out: the operating method later handed to the administrator will come out of what we have lived through. Second, because a director who knows the procedure in detail defends his file better before the authority. The administrator is recruited only once the process has been run in, at around fifteen coordinations a month.

To be discarded: the figures of “250 metres from residential areas” and “50 metres of height” that circulate on flight-school websites come from an old article of the 1981 regulation. They have not applied to small drones since 2024.
Everything depends on the lawyer. Six critical questions determine feasibility, starting with: can a single authorisation cover the whole activity, or is one application needed per job?
The six critical questions put to the lawyer
Ref Question What it decides
A2 Does the 25 kg threshold include the water load? The choice of equipment
A6 Is the threshold assessed on the manufacturer’s MTOW or on the mass as actually configured? Rules out or brings back several models
B1 Does תקנה 32(א)(2) indeed rule out cleaning an occupied façade in practice? Feasibility itself
B2 Does the הרשאה להפעלה מיוחדת allow a waiver from it? Is there a precedent? Feasibility itself
B3 Does a single authorisation cover all our job sites, or is one application needed per building? The whole business model
B8 Can the application be filed before the drones are bought and registered? 270 000 ₪ tied up or not
The timeline, tightened

Month 1 company, van and aircraft ordered, recruitment started, website and CRM · Month 2 delivery and fit-out, registration, spectrum authorisation, field pair in post mid-month · Month 3 authorisation application filed, pressure washing in production, campaign launched at day 90 · Months 4-6 file under review, first residential leads, order book built · as soon as the authorisation lands first billable drone job.

The critical path is no longer our organisation, it is the authorisation. Van, equipment, crew, website and campaign are ready by the end of the third month. All the rest of the timeline sits in a single box we do not control — hence the importance of questions B1 to B3 put to the lawyer.
The plan B if the authorisation is slow to come. Three activities stay open without any waiver and cover part of the fixed costs: ground-level pressure washing, which falls under no air regulation; solar panel cleaning on open roofs, where the distance rule can be met; and isolated industrial sites, compliant by nature for want of third parties nearby. We are not left without revenue while waiting for a signature.

Operations

Decisions and positions taken

Question Position taken
Crew composition Two people: a drone pilot and a crew leader who holds the visual watch and the ground
Vehicle A panel van above 3.5 t, 1 714 kg of payload, 12.4 m³. The drone travels under cover, dry and locked away
Water capacity A 400-litre buffer tank, not 1 000. A cubic metre of water weighs a tonne. Continuous supply comes from the building’s water point through the reverse-osmosis unit
Second trade Ground-level pressure washing runs on the same van and the same equipment. It invoices from the third month, funds the review of the file and fills the windy days
The payload budget, line by line: crew 170 kg, full tank 435, generator 70, reverse-osmosis unit 40, pump 60, hose reels 50, drone in its case 45, PPE and safety marking 60. Total 930 kg out of 1 714 available — 784 kg of margin.
The payload budget, line by line
Item Mass
Crew, two people 170 kg
400 L buffer tank, full 435 kg
Generator 70 kg
Reverse-osmosis unit and pre-filters 40 kg
High-pressure pump 60 kg
Hose reels and hoses 50 kg
Drone in its transport case 45 kg
PPE, safety marking, consumables 60 kg
Total 930 kg out of 1 714 available
The cycle of a job

T−15 pre-visit and site survey · T−10 flight coordination filed, seven working days minimum · T−7 residents informed and written agreement from the property management company · T−1 weather and restrictions check · T0 safety marking, call to the control unit, visual observer at all times · T+1 mission report, invoicing, review request.

The ten-day lead time cannot be compressed and we sell it as such. Our promise is not immediate intervention: it is a quote within twenty-four hours and a firm date given straight away.

The forecast

Decisions and positions taken

Question Position taken
Funding 600 000 ₪ of founders’ equity + 369 000 ₪ of balloon loan on the van and the drones. No working capital loan: the cash position never turns negative
What we ask of the bank A business account, the best rate on the equipment balloon loan, and a 100 000 ₪ overdraft facility that costs nothing as long as it is not drawn
Vehicles and aircraft Balloon loan pledged in favour of the lender. The pledge is worth about four points of interest: 5.3% effective recorded against 9.5% without a pledge. The forecast nevertheless keeps 8%, as long as no bank quote is signed: that is the prudent assumption, and every point of rate gained is worth more than 10 000 ₪ over forty-eight months
Partners’ salaries Zero in the first year. Remuneration at the year end, out of profit
The field pair In post mid-month 2, pilot recruited already licensed. He produces pressure washing revenue from month 3
Second crew On measured triggers only: 14 of the 17 production days booked, two months running
The cash trough is 23 932 ₪ in the ninth month. That is ten days of costs, and we say so rather than hide it. Ground-level pressure washing has to run seventeen days a month from the third to the sixth: it is what holds the cash position while the file is under review.
The Israeli balloon loan trap. The final payment is very generally indexed to the מדד. At 3% inflation, an 86 700 ₪ balloon exceeds 94 000 ₪ in four years while every instalment has been paid perfectly. To be demanded as a firm amount.

The choice of drone

What was ruled out, and why

Aircraft Mass Verdict
DJI Agras T25 32 kg Ruled out — 25.4 kg empty, already above the threshold
DJI Agras T50 52 kg Ruled out
DJI Agras T100 75 to 90 kg Ruled out — seven times the threshold
XAG V40 / P100 / P150 28 to 51 kg Ruled out
Aerones 55 kg Ruled out, and not sold — service provision only
Drone Volt Hercules 20 MTOW 33 kg Ruled out — 8 kg above the threshold
Hercules 10 Tethered MTOW 20 kg Selected — 5 kg of margin
DJI Matrice 400 MTOW 15.8 kg Selected — 9.2 kg of margin
The two aircraft selected
Hercules 10 Tethered Spray DJI Matrice 400 + kit
Origin France — Villepinte China
Empty mass 8.5 kg manufacturer · 10 9.74 kg DJI · 10
MTOW 20 kg manufacturer · 10 15.8 kg DJI · 10
Payload 7.5 kg 6 kg
Margin under 25 kg 5 kg guaranteed by the MTOW 9.2 kg guaranteed by the MTOW
Water supply A hose from the ground — the meaning of “Tethered” Third-party kit fed from the ground integrator · 6
Endurance Not published 59 min DJI · 10
Wind limit Not published 12 m/s DJI · 10
Distributor in Israel None — direct import from France dronevolt.com · 8 FlySafe, DJI Enterprise distributor official · 8
A naming trap. At DJI, the number after the T is the tank volume in litres, not the mass. The T25 is not a 25 kg aircraft: it weighs 32 kg with its battery. A supplier can offer it to you in good faith and be wrong.
To be obtained from Drone Volt before ordering: the price and content of the Hercules 10 Tethered Spray pack, its endurance, its wind resistance, and written confirmation that it exists in a façade-cleaning configuration and not only in agricultural spraying.
Import, line by line
Item Rate Detail
Tariff code 8806.23 Unmanned aircraft of 7 to 25 kg
Customs duty 0% All origins, until 31 May 2028
Purchase tax 0% Exempt
Import VAT 18% On the CIF value — recoverable, a drone is not a vehicle
Customs broker 1 500 to 4 000 ₪ Market estimate, to be quoted
Delivered cost 118 000 to 133 000 ₪ on the basis of the only published pack, 26 850 € excluding VAT
The blocking point is not customs, it is the Ministry of Communications. A spectrum authorisation — אישור תקשורת 1301 — is mandatory before the goods arrive for any aircraft containing a radio component. Failing that: equipment impounded and a fine. File: invoice, manufacturer’s catalogue with frequencies and transmission power, the manufacturer’s radio report. Authority: ממונה אישור יבוא ציוד, Ahad Ha’am 9 Tel-Aviv, 03-519-8154.

No Ministry of Defence control for an import destined for Israel — the two security authorisations in the tariff cover only the West Bank and Gaza. And no public list of models approved by the CAA: registration is done aircraft by aircraft, on file.

The choice of vehicle

Why a panel van and not a pickup

Over five years D-Max S Plus Transit 399L
List price 300 990 ₪ 289 000 ₪
Recoverable VAT 0 ₪ − 44 085 ₪
Deductible costs 45% 100%
Enclosed volume 1.18 m³ 12.4 m³
Payload 1 080 kg 1 714 kg
Total cost 300 990 ₪ 208 508 ₪
The dividing line is a tax line, at 3 500 kg. In Israel VAT is not recoverable on a vehicle of 3 500 kg or less, even when it is used 100% for the business — תקנה 14(א), regulation 14(a). Above that weight, everything changes. The price of crossing the line is a C1 driving licence: 6 500 to 10 000 ₪ and two to three months.
Caveat. The Transit price comes from the motor trade press, not from the importer, and Ford’s official commercial vehicle site no longer shows the diesel Transit. Written confirmation from Delek Motors is required — failing that, the Renault Master 3.99T at 354 000 ₪ takes its place.
The ten panel vans compared
Model Price incl. VAT Gross weight Payload Volume Verdict
Ford Transit 399L 289 000 ₪ 3 990 1 714 kg 12.4 m³ Selected
Renault Master 3.99T L3H2 354 000 ₪ 3 990 1 738 kg 13.0 m³ Fallback
Renault Master 3.99T L2H2 348 100 ₪ 3 990 1 811 kg 10.8 m³ Compliant
Iveco Daily L4H2 325 000 ₪ 3 800 1 452 kg 16.0 m³ If volume comes first
Fiat Ducato POWER XL 389 400 ₪ 3 995 1 810 kg 13.4 m³ Expensive
Peugeot Boxer L4H3 380 000 ₪ >3 500 1 745 kg 17.0 m³ Expensive
Renault Master 3.5T ≤390 000 ₪ 3 500 1 360 kg 10.8 m³ Only B-licence option
Mercedes Sprinter 316 340 000 ₪ 3 550 1 250 kg 14.0 m³ Ruled out
VW Crafter 3.5t 398 250 ₪ 3 500 1 009 kg 14.4 m³ No payload margin
Sprinter 314 entry level 275 000 ₪ 3 550 990 kg 7.8 m³ No payload margin
The pickups examined
4×4 model Price incl. VAT Payload Bed volume
Isuzu D-Max 1.9 S Plus 300 990 ₪ 1 080 kg 1.18 m³
Toyota Hilux Active Pro 309 990 ₪ 1 000 kg 1.15 m³
Ford Ranger XLT 294 000 ₪ 1 000 kg 0.98 m³
KGM Musso 2.2 274 900 ₪ ~1 000 kg not found
Mitsubishi L200 No longer sold new in Israel in 2026
The figure that disqualified the pickup bed: 1.18 m³. Under a hardtop, that is what the D-Max offers to hold a drone case, a pump, a reverse-osmosis unit, a generator, two hose reels, a 400-litre tank and the kit for two people. The panel van offers ten times more. The payload just about worked; the volume did not work at all. Second finding: the 4×4 and the 240 mm of ground clearance buy a capability that urban tarmac jobs will never call on.
The second vehicle

The financial forecast carried 130 000 ₪. That is three times too much for a vehicle that does site surveys and carries nothing heavy. Second-hand market values: Berlingo 2018-2020 from 30 800 to 69 700 ₪, Doblo from 22 400 to 41 200 ₪, Kangoo 2019-2021 from 29 600 to 49 900 ₪. Target: 35 000 to 55 000 ₪ in cash after a בדיקת רכב (vehicle inspection), that is about 43 000 ₪ saved over thirty months.

Wrap, fit-out, trailer
Item Budget Source
Full wrap on one van 5 500 ₪ + 500 ₪ Actual customer quote midrag · 6
Partial lettering 750 to 1 500 ₪ excluding VAT Best visibility for the money midrag · 6
Modular racking 2 500 to 4 000 ₪ Supplier’s own statement roimitech · 4
Bespoke fit-out 10 000 to 30 000 ₪ No public rate · 4
Basic open trailer from 4 900 ₪ excluding VAT Published price list nissenboim · 5
Drop-side trailer, 2 t and above from 14 500 ₪ excluding VAT Braking sends the price up
Commercial vehicle insurance 6 500 to 8 500 ₪ a year Official quotes on car.cma.gov.il midrag · 4
Annual roadworthiness test ≤ 8 t 126.19 ₪ Official rate 01.06.2026 m-rishuy · 8
The trailer weight allowed on a B licence is not settled. תקנה 180(ב) caps it at 1 500 kg; a training body documents an October 2023 amendment imposing a combined limit of 5 000 kg; a third source puts it at 4 250 kg. With a gross vehicle weight of 3 990 kg that gives 1 500, 1 010 or 260 kg. No consequence for the launch: with 12.4 m³ and 784 kg to spare, the trailer is not needed to start.

The price list

How it was built

Method Day rate Price per m²
Rope access, entry level 3 300 ₪ 5.5 ₪/m²
Rope access, top of the range 5 900 ₪ 9.8 ₪/m²
Boom lift with operator 4 750 ₪ 6.8 ₪/m²
Published pressure washing 15 ₪/m²
Our price list 5.2 to 7.5 ₪/m²
No reference price for drone work exists in Israel. None of the five operators publishes a rate, and Electra FM states in writing that the business model is still being finalised. No anchor, therefore no price war: the first to publish a coherent price list sets the reference.
The prices per m² above are our own reconstruction, derived from published day rates and an assumed rate of 600 m² per day for a rope access crew. None of these providers publishes a price per m².
This market is not sold by the square metre

Not the rope access firms, not the boom lift operators, not the scaffolders. They sell by the crew day and as a fixed price per building. Only one provider publishes a price per m² in Israel. Our price list is therefore built per m² internally and presented to the client as a fixed price — a ועד בית thinks in shekels per flat, not in square metres of façade.

Sensitivity to the rate
Washing rate Jobs per month Summer monthly revenue Margin
600 m² per day 6.7 65 671 ₪ −11 916 ₪
750 m² per day 8.0 78 681 ₪ −467 ₪
900 m² per day — adopted 9.2 90 654 ₪ +10 069 ₪
1 100 m² per day 10.7 105 209 ₪ +22 877 ₪
1 300 m² per day 12.1 118 365 ₪ +34 455 ₪

We have deliberately set aside the “80 to 90% less time” claimed by competitors: the washing itself speeds up a great deal, but the set-up, the water supply, the safety perimeter and the observer do not compress. 900 m² a day, about one and a half times a rope access crew, is prudent. To be measured stopwatch in hand on the first three jobs, separating actual washing time from the rest.

The documented seasonality is meteorological, not religious. Two windows: the end of winter, and the autumn before the rains. The peak before Passover is documented only for domestic cleaning, never for façades. Same for sandstorms and the Tishrei holidays: nothing. Do not set the advertising budget by the festival calendar without checking it first.
